CRM implementation is more than flipping a software switch. It includes planning, configuration, data migration, integrations, testing, training, go-live, and the stabilization period afterward. Skip any of these and adoption suffers, even if the software itself works fine.
This article breaks down realistic timeline ranges by project complexity, walks through the factors that stretch or shrink those ranges, and shows you how to build an estimate specific to your organization instead of relying on a generic average.
Key Takeaways
- Treat basic CRM setup and full organization-wide rollout as separate projects with separate timelines.
- Most overruns come from data migration, custom integrations, unclear requirements, and slow stakeholder decisions.
- Configuration isn't "ready" until data accuracy, workflow testing, and user training are done.
- Build your timeline from your own requirements and dependencies, not borrowed industry averages.
What Is the Average CRM Implementation Time?

Based on current benchmarks from CRM consultancies and vendors, here's a realistic range:
| Project Type | Typical Timeline |
|---|---|
| Small business, straightforward setup | 1-3 months |
| Mid-sized rollout with moderate complexity | 3-6 months |
| Large enterprise, advanced needs | 6-12+ months |
Salesforce notes a small-business implementation can take a few weeks, while an enterprise deployment with intricate integrations may stretch to several months, according to Salesforce's CRM implementation guide.
One CRM implementation partner reported that roughly 78% of CRM projects take 3-6 months, per HarvestROI's 2024 analysis. That figure comes from a partner's own client base, not a market-wide study.

How Timelines Vary by Implementation Scope

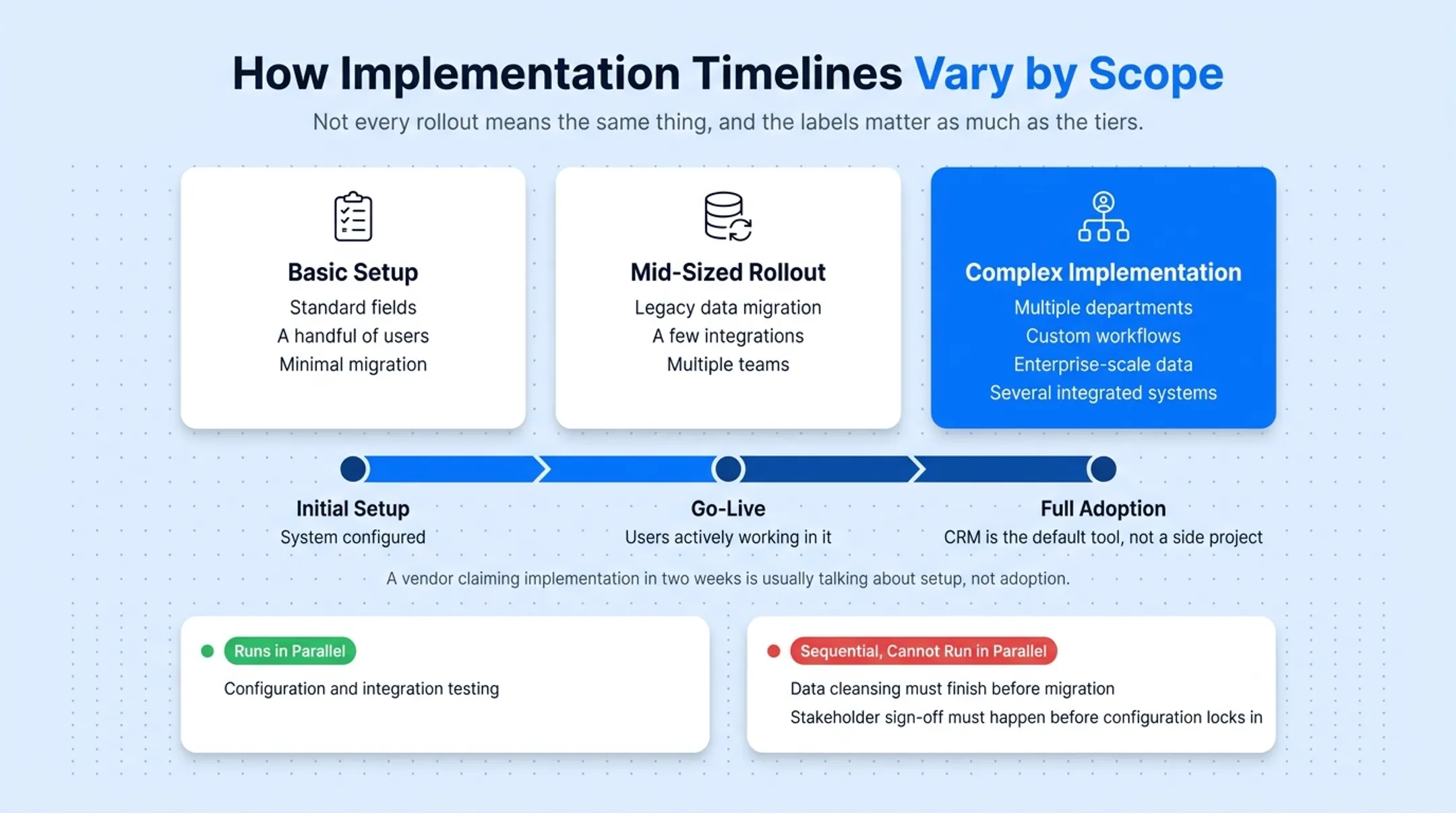

Not every "implementation" means the same thing. Three common tiers:
- Basic setup: Standard fields, a handful of users, minimal migration
- Mid-sized rollout: Data migration from a legacy system, a few integrations, multiple teams
- Complex implementation: Multiple departments, custom workflows, enterprise-scale data, several integrated systems
Timeline labels also matter. Initial setup (system configured), go-live (users actively working in it), and full adoption (the CRM is the default tool, not a side project) are three separate milestones. A vendor claiming "implementation in two weeks" is usually talking about setup, not adoption.
Calendar time and active effort aren't the same either. Configuration and integration testing can often run in parallel. Other steps cannot:
- Data cleansing must finish before migration
- Stakeholder sign-off must happen before configuration locks in
Those sequential dependencies are usually what stretch a project past its original estimate.

What Determines CRM Implementation Time?
Five factors drive most of the variance between a six-week project and a nine-month one.
Organization size and structure
More users, departments, and decision-makers means more requirements-gathering, more permission tiers, and longer approval cycles. A 10-person sales team can agree on a pipeline structure in one meeting. A 200-person org across four regions cannot.
Data migration
This is often the single biggest wildcard. Consider:
- Number of records and source systems
- Duplicate or outdated entries
- Missing or inconsistent fields
- Whether a test migration runs before the final cutover
Cleaning and mapping data while preserving essential history and pipeline structure is non-negotiable. Skip that step and you end up with a CRM full of garbage data that nobody trusts within a month of go-live.
Customization and process complexity
Custom fields, multi-stage pipelines, automation rules, and approval paths all add configuration time. A project that includes automated lead logging, enrichment, and post-capture messaging takes longer than one using out-of-the-box pipelines, but it also delivers more once live.
Integration type
Native integrations (connecting to tools the CRM already supports) move fast. Third-party connectors take longer to test. Custom API integrations (for example, linking a CRM to a legacy ERP) require the most testing and troubleshooting, since no pre-built connector is doing the heavy lifting.

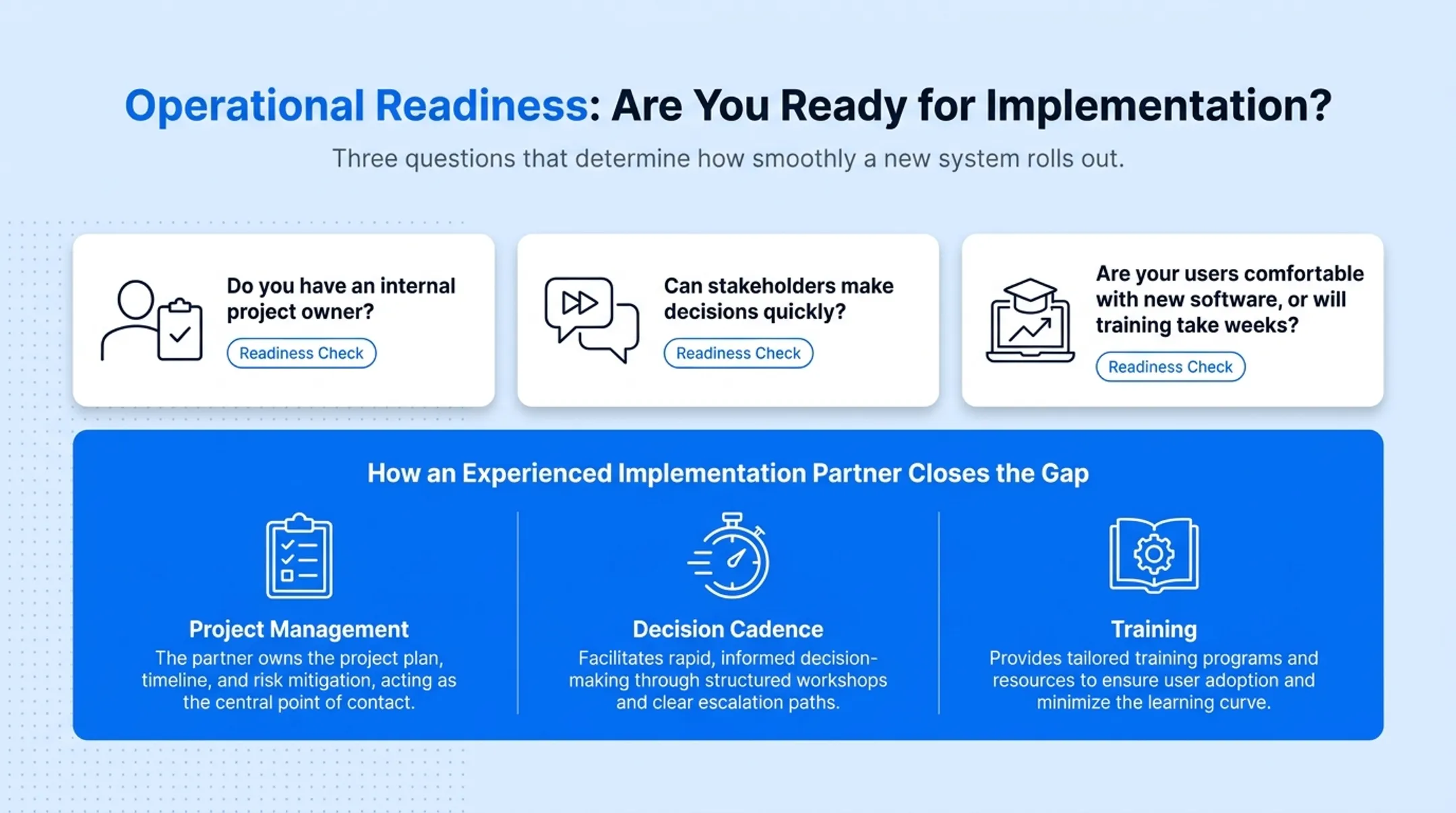

Operational readiness
Do you have an internal project owner? Can stakeholders make decisions quickly? Are your users comfortable with new software, or will training take weeks? An experienced implementation partner shrinks these gaps by owning project management, decision cadence, and training.

The Main Phases of CRM Implementation
CRM implementation usually runs through five phases. Each one has clear outputs, and cutting any short almost always stretches the overall timeline.
Planning and Requirements Definition
This phase locks down the foundation before anyone configures the system:
- Business goals and success measures
- Current-process map
- User requirements and scope document
Unresolved decisions here, such as which fields are mandatory or who owns lead assignment, delay everything downstream. Don't skip this phase to save time; it costs more later.
Configuration and Customization
This is where teams build the working system:
- Pipelines and custom fields
- Roles and permissions
- Dashboards and automation rules
Ship a minimum viable configuration first. Optional extras (additional dashboards, nice-to-have automations) can wait until the core system is stable.
Data Migration and Integrations
This phase covers the data and connection work:
- Data inventory and cleansing
- Field mapping and import validation
- Integration setup
A controlled test migration (moving a sample batch first) catches mapping errors before they hit your entire customer database.
Testing and User Training
Role-based training and user acceptance testing happen here, using realistic sample records rather than blank test accounts. Workflow checks, integration tests, and report validation all need to pass before go-live. Keep a documented process for logging issues as they surface.
Go-Live and Stabilization
Phased rollouts (one team first, then the rest) reduce risk compared to an all-at-once launch. After go-live, monitor data quality and user activity closely. Keep a backlog for improvements that should not delay the initial release.

How to Keep CRM Implementation on Schedule
A few early choices keep most CRM rollouts on track. Treat these as non-negotiables, not nice-to-haves:
- Define a focused first release. Document nonessential requests separately and postpone them until the core workflow is stable.
- Assign one accountable owner and a small decision-making group. Vague ownership is the fastest way to stall a project.
- Start data cleanup early. It's usually the longest lead-time task and the easiest to underestimate.
- Use native integrations or proven templates where they fit; save custom API work for cases that truly require it.
- Involve end users before configuration locks in. Their feedback catches usability issues before they're baked into the system.
- Add a buffer based on identified risks, not a generic 10-15% padding.
According to Forrester's 2022 analysis on CRM change management, CRM projects often stall when business and IT teams aren't aligned on goals, metrics, and funding before work starts. That misalignment, more than any technical hurdle, is what pushes timelines out.
Conclusion
The "average" CRM implementation time is a range, not a fixed number. Scope, data quality, integrations, customization, and how fast your team decides all shape the timeline. Company size matters, but it isn't the whole story.
Build your estimate from the work itself:
- Break the project into phases and time each one
- Flag dependencies and risks before kickoff
- Define what "ready to launch" means for your team
- Revisit the schedule as requirements firm up
A plan built this way beats chasing a borrowed industry average.
Frequently Asked Questions
How long does a CRM implementation typically take?
Timelines range from a few weeks for a basic small-business setup to 6-12+ months for a complex, multi-team enterprise rollout. Your actual timeline depends on the scope factors covered above, not company size alone.
How much does it cost to implement a CRM?
Budget for licenses (about $12–$200+ per user/month) plus labor, data migration, integrations, customization, and training. Labor alone typically runs $12,000 for small businesses to $180,000–$420,000 for enterprises, per Technology Advisors' 2024 CRM cost guide.
What factors can delay a CRM implementation?
Unclear scope, poor data quality, custom integrations, slow stakeholder decisions, insufficient testing, and weak user readiness are the most common causes. Misalignment between business and IT teams on goals before the project starts is a frequent root cause too.
Can a small business implement a CRM quickly?
Yes. With a simple workflow, limited data migration, native integrations, and a focused user group, a small business can go live in a few weeks. Poor preparation can stretch even a simple project well past that.
How do you know when a CRM is ready to go live?
Look for validated data, working core workflows and integrations, completed user acceptance testing, and trained users. You'll also want documented processes, assigned support ownership, and a plan for handling post-launch issues.
