CRM implementation is bigger than creating user accounts. It's the combined work of setting business goals, mapping workflows, cleaning data, configuring the system, training your team, and improving things after launch. Skip any of these steps and you end up with expensive software nobody trusts.
This guide covers a practical six-step roadmap, best practices for adoption and data quality, the four pillars every CRM needs, common mistakes to avoid, and how to measure whether your implementation actually worked.
Key Takeaways
- Define business outcomes and map customer journeys before comparing CRM platforms
- Migrate only clean, relevant data with clear ownership for ongoing quality
- Launch a simple, tested configuration with role-based training—not every feature at once
- Track adoption, data quality, and workflow efficiency continuously, not just at launch
CRM Implementation Roadmap: 6 Essential Steps

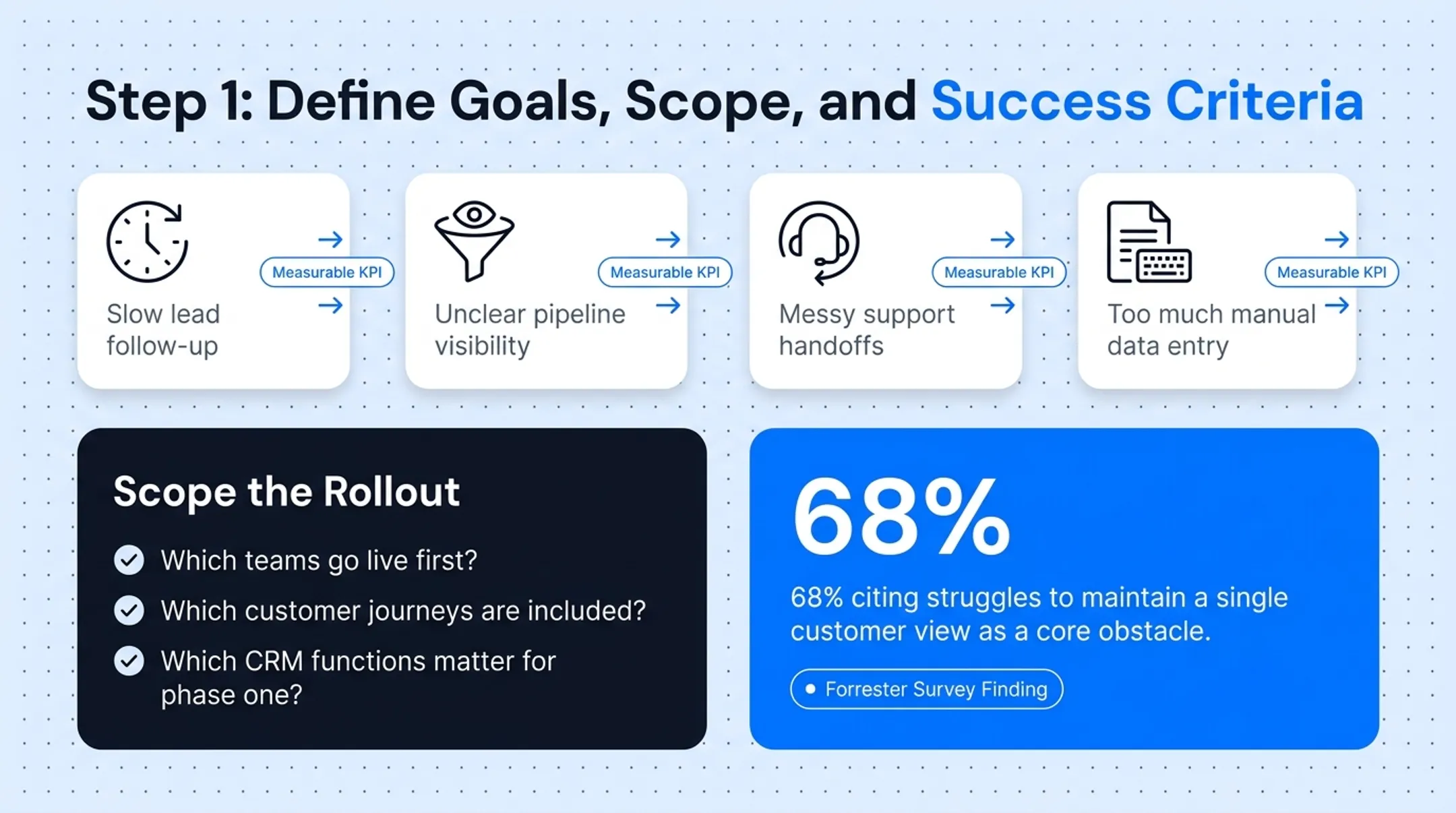

Step 1: Define Goals, Scope, and Success Criteria
Start by naming the actual business problems: slow lead follow-up, unclear pipeline visibility, messy support handoffs, too much manual data entry. Turn each into a measurable KPI.
Then scope the rollout:
- Which teams go live first?
- Which customer journeys are included?
- Which CRM functions matter for phase one?
A Forrester survey found that among people involved in a recent CRM implementation, most didn't consider it successful—with 68% citing struggles to maintain a single customer view as a core obstacle. Vague goals are usually the root cause.

Step 2: Build the Team and Audit Current Processes
Assign clear roles:
- Executive sponsor — removes roadblocks, reinforces priority
- Project lead — owns timeline and decisions
- CRM administrator — manages configuration long-term
- Department reps and end-user champions — represent daily reality
Before redesigning anything, document how leads currently enter the business, how deals progress, where handoffs happen, and where information gets lost today.
Step 3: Choose the CRM That Fits Your Operating Model
Build a requirements checklist covering ease of use, scalability, integrations, reporting, automation, permissions, mobile access, and total cost. Compare each shortlisted platform against your documented workflows, not marketing pages.
Involve the people who'll actually use it daily. A platform with more features isn't better if your sales team never touches half of them.

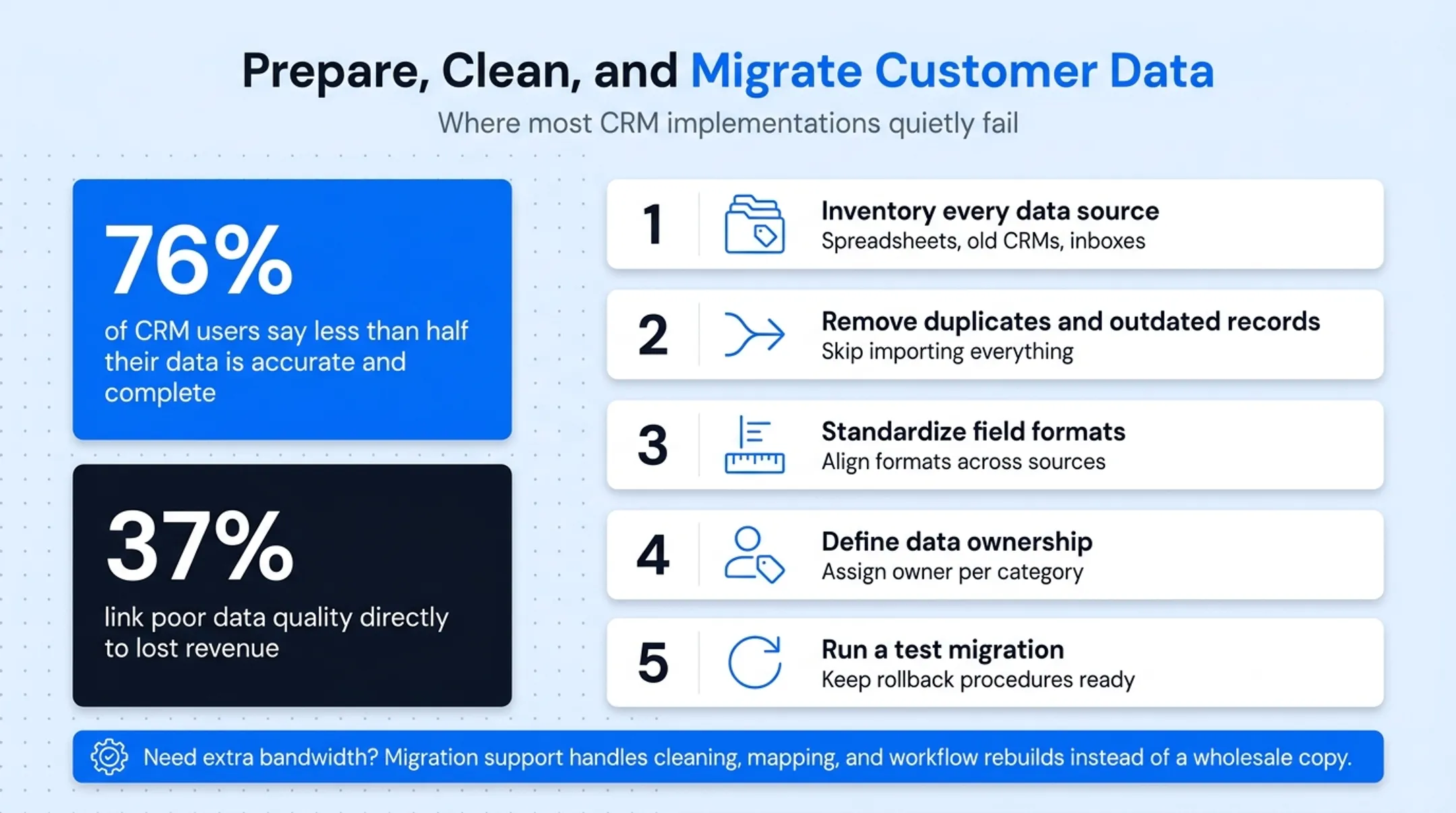

Step 4: Prepare, Clean, and Migrate Customer Data
This is where most implementations quietly fail. Validity's 2025 report found that 76% of CRM users said less than half of their organization's data was accurate and complete, and 37% linked poor data quality directly to lost revenue.
Before migration:
- Inventory every data source — spreadsheets, old CRMs, inboxes
- Remove duplicates and outdated records rather than importing everything
- Standardize field formats across sources
- Define ownership for each data category
- Run a test migration with rollback procedures ready
If internal bandwidth is tight, migration support can cover cleaning and mapping data, preserving essential history, and rebuilding workflows instead of copying files over wholesale.

Step 5: Configure Workflows, Integrations, and Controls
Set up core objects, lifecycle stages, required fields, lead-routing rules, dashboards, and permissions. Connect the tools your team already lives in: email, calendars, forms, accounting, marketing, help desks.
Keep version one close to a minimum viable workflow. Test automation and access controls with real sample records before rolling out broadly. Connect the CRM to your website, calling tools, and ERP early so teams stop re-entering the same data in multiple systems.
Step 6: Pilot, Train, Launch, and Optimize
Start with a small pilot group. Let them stress-test workflows, flag confusing fields, and validate that reports pull the right numbers.
Salesforce recommends thorough testing with a small pilot group before scaling broadly. That same pilot-first pattern shows up across nearly every successful rollout. After go-live:
- Collect feedback on week one, week four, and week twelve
- Make controlled improvements, not sweeping changes
- Use launch day as the baseline for ongoing optimization
CRM Implementation Best Practices
Establish Governance and Clear Ownership
Someone needs to own decisions: who creates fields, who approves automations, who resolves data disputes. Document naming conventions and change-control procedures so the system stays consistent as your team grows.
Design for User Adoption
Explain, role by role, how the CRM reduces duplicate work or improves visibility. Involve users in workflow decisions instead of dictating from the top. Use champions, quick-reference guides, and management reinforcement to make the CRM the actual source of truth, not an optional reporting chore.
Protect Data Quality From Day One
- Set required-field standards for contacts, accounts, and lifecycle stages
- Use validation rules and duplicate-prevention checks
- Assign ownership for ongoing cleanup
- Schedule recurring data audits
Customize Enough—But Not Too Much
Configure around your actual sales, marketing, onboarding, and support workflows. Resist unnecessary custom fields and branching automations that add administrative overhead without solving a real problem. Test every customization with end users before it goes live.
Connect Automation and Support Thoughtfully
Automate repetitive work such as lead assignment, follow-up reminders, task creation, and escalations—including lead capture, qualification, and pipeline updates. Keep human review for sensitive, high-value interactions. Link sales, marketing, and support records so reps see full history without customers repeating themselves.

The Four Key Pillars of a CRM
| Pillar | What It Covers | Why It Matters |
|---|---|---|
| People | Sponsors, admins, managers, end users, champions | Determines whether the CRM becomes daily habit or gets ignored |
| Process | Lead capture through renewal, shared stages, handoffs | Creates a consistent customer experience across teams |
| Data | Quality, completeness, migration controls | Bad data undermines every report and interaction built on top of it |
| Technology | Integrations, automation, security, dashboards | Should support agreed processes, not compensate for undefined ones |
Technology can't fix unclear ownership. A clean data model can't rescue a process nobody follows. These pillars work together or the whole system wobbles.

Common CRM Implementation Mistakes to Avoid
Choosing Software Before Defining Requirements
Feature-led selection often produces a system too complex or poorly matched to actual workflows. Document use cases and involve end users before comparing vendors.
Migrating Poor Data While Over-Customizing
Duplicates, inconsistent formats, and complicated automations erode trust immediately after launch. Clean data first, launch a limited first-phase configuration, then add complexity based on real feedback instead of guesses.
Treating Implementation as an IT Project
Sales, marketing, support, and leadership all need a seat at the table during workflow design. Without an executive sponsor and accountable administrator, adoption stalls fast. Forrester research flags weak cross-organizational cooperation—more than technology gaps—as a common reason CRM rollouts stall.
How to Measure CRM Implementation Success
Track Adoption and Data-Quality Signals
Login volume alone proves nothing. Measure:
- Active usage by role
- Completed activities vs. baseline
- Record completeness and duplicate rate
- Stage accuracy against defined workflows
Connect CRM Usage to Business Outcomes
Tie metrics directly to your original goals:
- Lead response time and conversion rate
- Sales cycle duration and forecast reliability
- Support resolution time and retention
Pick the metrics that map to what you set out to fix in Step 1. Track only what maps to those goals—not every dashboard widget available.

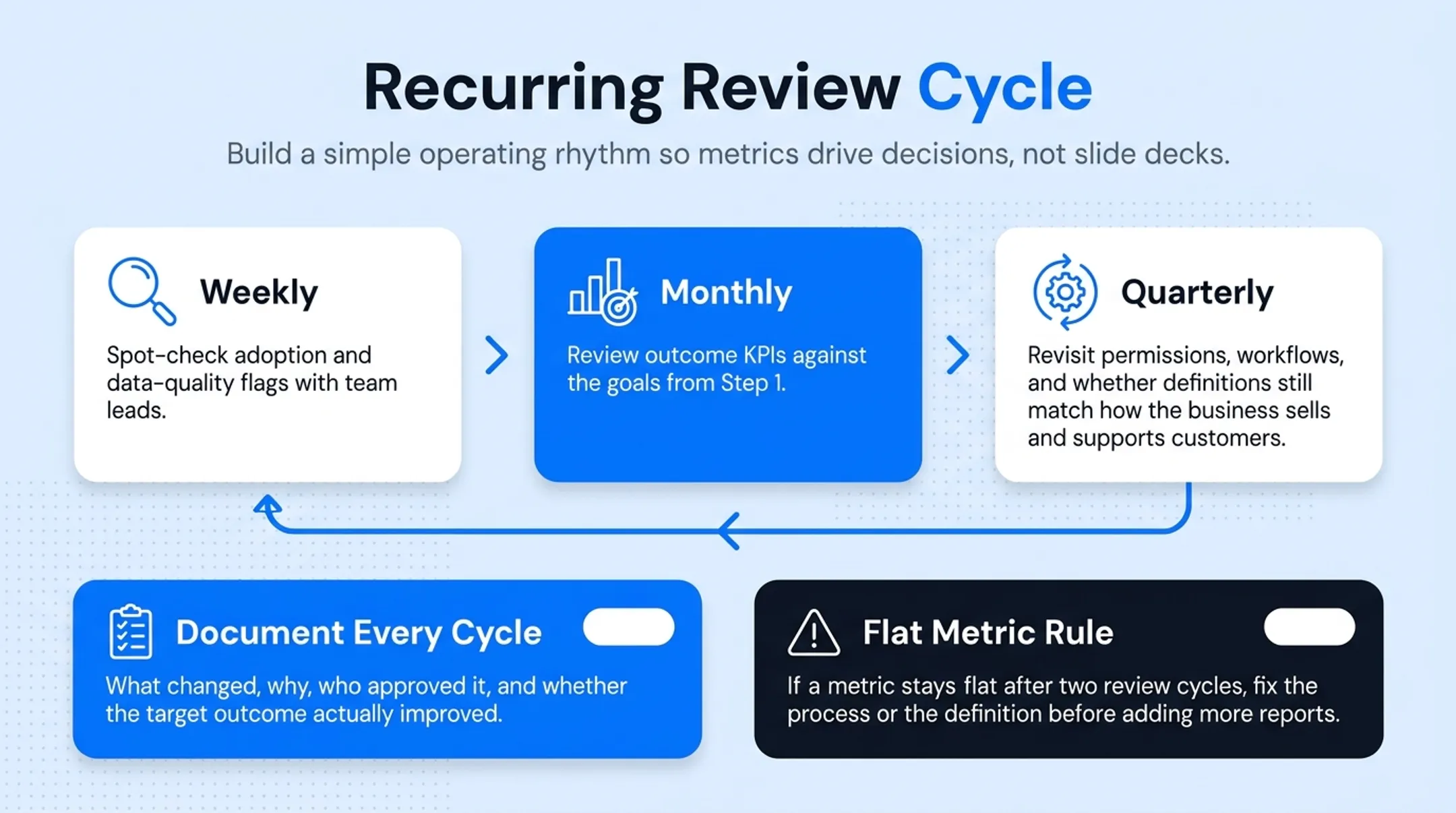

Create a Recurring Review Cycle
Build a simple operating rhythm so metrics drive decisions, not slide decks:
- Weekly: spot-check adoption and data-quality flags with team leads
- Monthly: review outcome KPIs against the goals from Step 1
- Quarterly: revisit permissions, workflows, and whether definitions still match how the business sells and supports customers
Document what changed, why, who approved it, and whether the target outcome actually improved. If a metric stays flat after two review cycles, fix the process or the definition before adding more reports.

Frequently Asked Questions
What are the steps in CRM implementation?
Core steps cover planning, build, and rollout: set goals, assess processes and stakeholders, select the CRM, clean and prepare data, configure the system, integrate tools, train users, test, launch, then optimize on an ongoing basis.
What are best practices for CRM implementation?
Prioritize process-first planning, clean data, appropriate (not excessive) customization, user involvement, role-based training, thoughtful automation, clear governance, and regular post-launch reviews.
What is CRM in customer support?
Support teams use CRM records to view full customer history, manage cases, coordinate handoffs between departments, automate follow-ups, and deliver more consistent service without asking customers to repeat themselves.
What are the key components or pillars of a CRM?
The four pillars are people, process, data, and technology. They work together: technology supports agreed-upon processes, while people and clean data determine whether those processes actually stick.
How long does CRM implementation take?
Timing depends on team size, data complexity, integrations, and customization scope. Simple rollouts can take a few weeks; complex, multi-department implementations often take several months, including time for testing and training.
How can a business improve CRM user adoption?
Involve users early in workflow decisions, keep the initial configuration simple, provide practical role-based training, designate internal champions, and reinforce usage through management, not just a one-time onboarding session.
