The stakes are real. Gartner forecasts that more than 70% of recently implemented ERP initiatives will fail to fully meet their original business-case goals by 2027, with as many as 25% failing outright. Panorama's 2026 ERP Report found more than a quarter of organizations went over budget, and almost a quarter blew past their timeline.
This guide breaks down exactly what to evaluate before you sign a contract, so your ERP investment supports growth instead of stalling it.
TL;DR
- Evaluate functionality, cost, scalability, and support before committing to any vendor
- Score vendors on business fit, TCO, integrations, track record, deployment model, and adoption readiness
- Avoid skipping stakeholder buy-in, demoing before a needs assessment, and underestimating ongoing costs
- Base the final decision on a structured framework, not a vendor sales pitch
What is an ERP System?
An ERP (Enterprise Resource Planning) system unifies finance, operations, HR, and supply chain data into one platform, replacing the disconnected spreadsheets and standalone tools most growing businesses start with.
ERP software comes in three deployment flavors:
- On-premise: installed and maintained on your own servers
- Cloud/SaaS: hosted by the vendor, accessed online, updated automatically
- Hybrid: a mix, useful when certain workloads need to stay on-site for compliance or security reasons

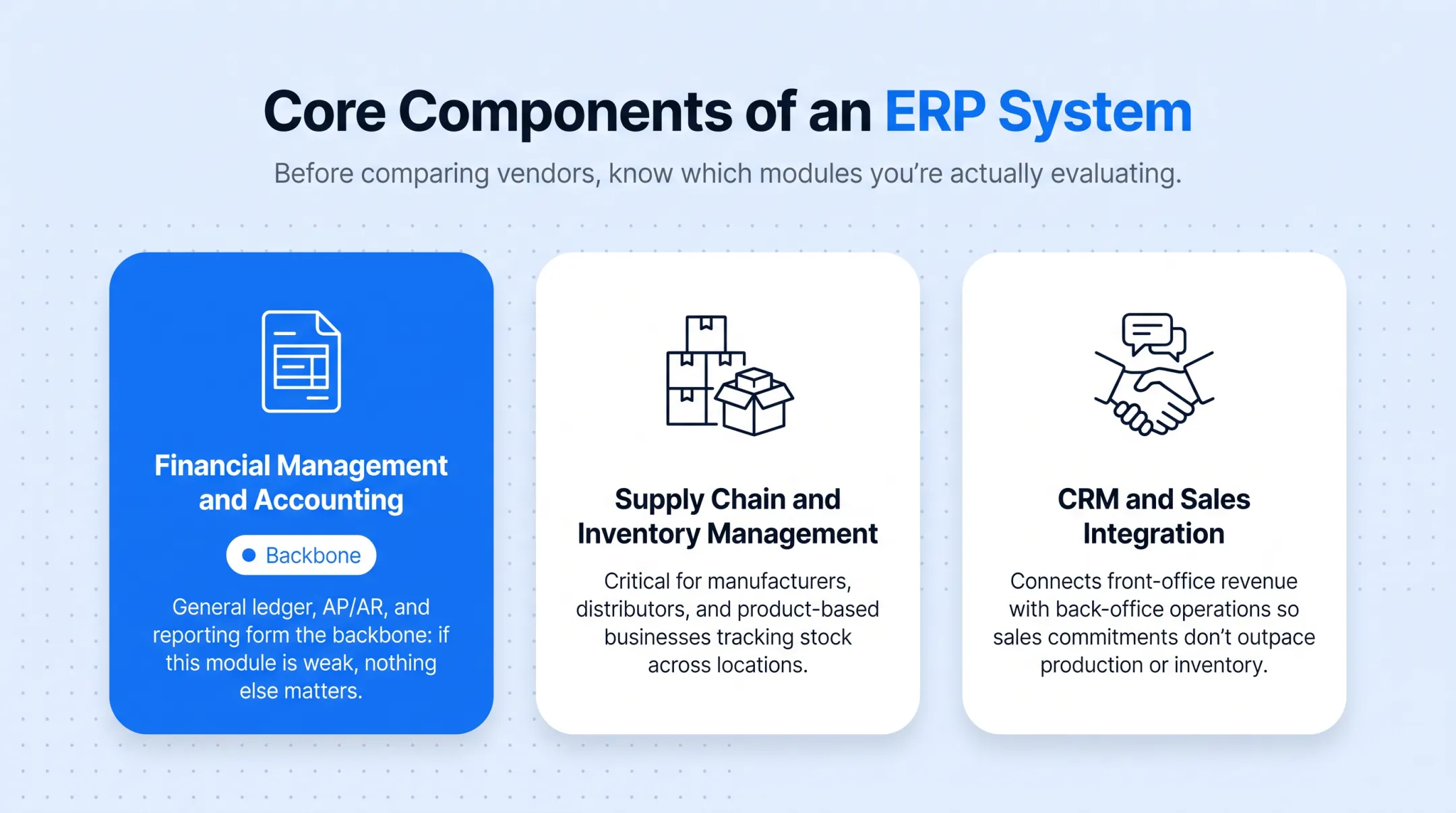

Core Components of an ERP System

Before comparing vendors, know which modules you're actually evaluating. Most ERP comparisons come down to three pillars:
- Financial management and accounting: General ledger, AP/AR, and reporting form the backbone—if this module is weak, nothing else matters
- Supply chain and inventory management: Critical for manufacturers, distributors, and product-based businesses tracking stock across locations
- CRM and sales integration: Connects front-office revenue with back-office operations so sales commitments don't outpace production or inventory

Why Businesses Rely on ERP Systems
- Reduces manual data entry across departments
- Speeds up financial close cycles
- Improves forecasting accuracy with unified data
- Eliminates data silos between finance, ops, and sales
What to Consider When Choosing the Best ERP System
Selection criteria shift depending on your industry, headcount, and growth stage. A shared evaluation framework still applies, and it helps finance and IT leaders turn technical specs into business outcomes they can measure.
Business & Functional Requirements Fit
Map your current pain points before you look at a single vendor demo. Separate must-have features from nice-to-haves; that one step prevents the scope creep that derails most ERP budgets. The tighter the fit, the higher your process automation rate and the fewer manual workarounds your team still needs after go-live.

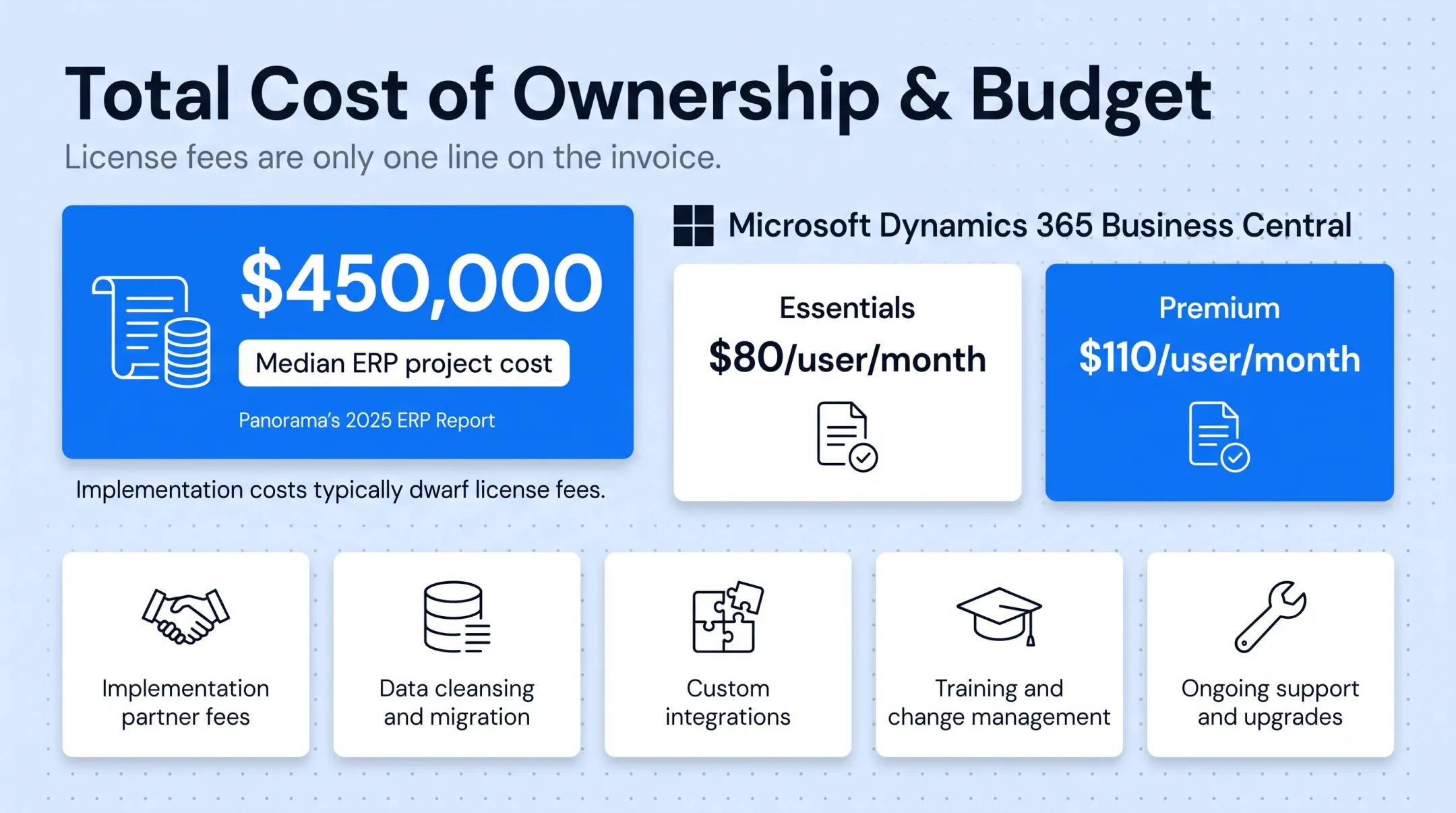

Total Cost of Ownership & Budget

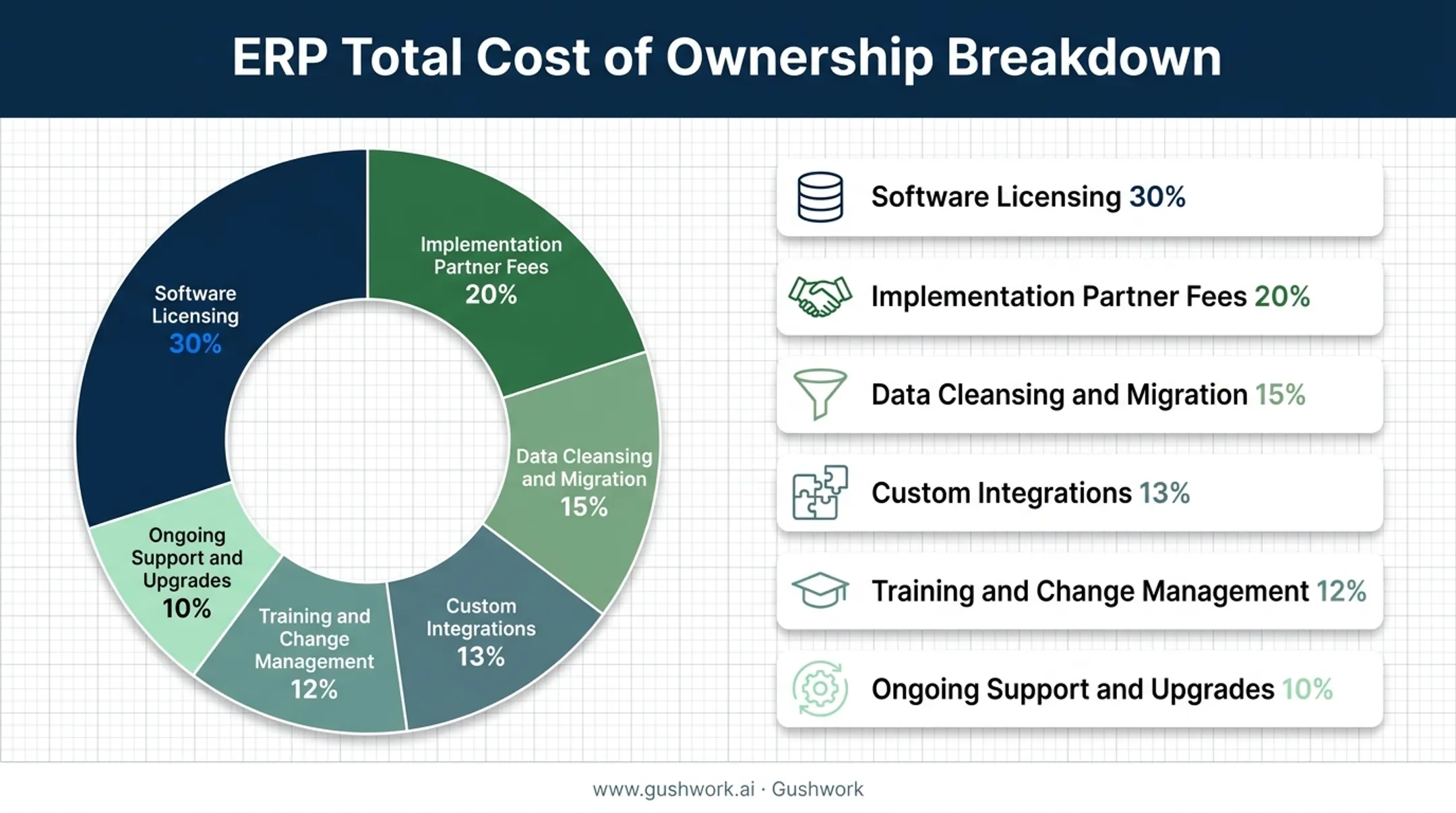

License fees are only one line on the invoice. Model licensing, implementation, data migration, training, and ongoing maintenance together.
Panorama's 2025 ERP Report found a median project cost of $450,000 across surveyed organizations. That sample skews toward larger, often multinational companies rather than a small US manufacturer, yet the pattern holds: implementation costs typically dwarf license fees.
On the license side, Microsoft's current US pricing for Dynamics 365 Business Central runs $80/user/month for Essentials and $110/user/month for Premium. That's just the software. Budget separately for:
- Implementation partner fees
- Data cleansing and migration
- Custom integrations
- Training and change management
- Ongoing support and upgrades

Integration & Scalability
Your ERP doesn't operate in a vacuum. It needs to talk to your CRM, e-commerce platform, and any third-party tools your team already relies on.
Panorama's research flags data integration and governance as some of the most persistent post-launch headaches, often driven by inconsistent KPIs and unclear data ownership. Syncing operational data through APIs, middleware, or event-driven workflows is essential, not optional.
Evaluate vendors on whether they can:
- Reduce data silos across finance, ops, and sales
- Limit system downtime during updates
- Scale users and licenses without a re-platform later
Vendor Track Record & Industry Experience
A vendor who's implemented systems for manufacturers isn't automatically qualified to implement one for a distributor. Industry-specific experience reduces implementation risk because the vendor already understands your workflows, compliance needs, and common failure points.
Ask for reference customers with similar complexity to yours — same industry, similar entity count, comparable integration needs. This shapes your implementation timeline accuracy and how fast you get support after go-live.

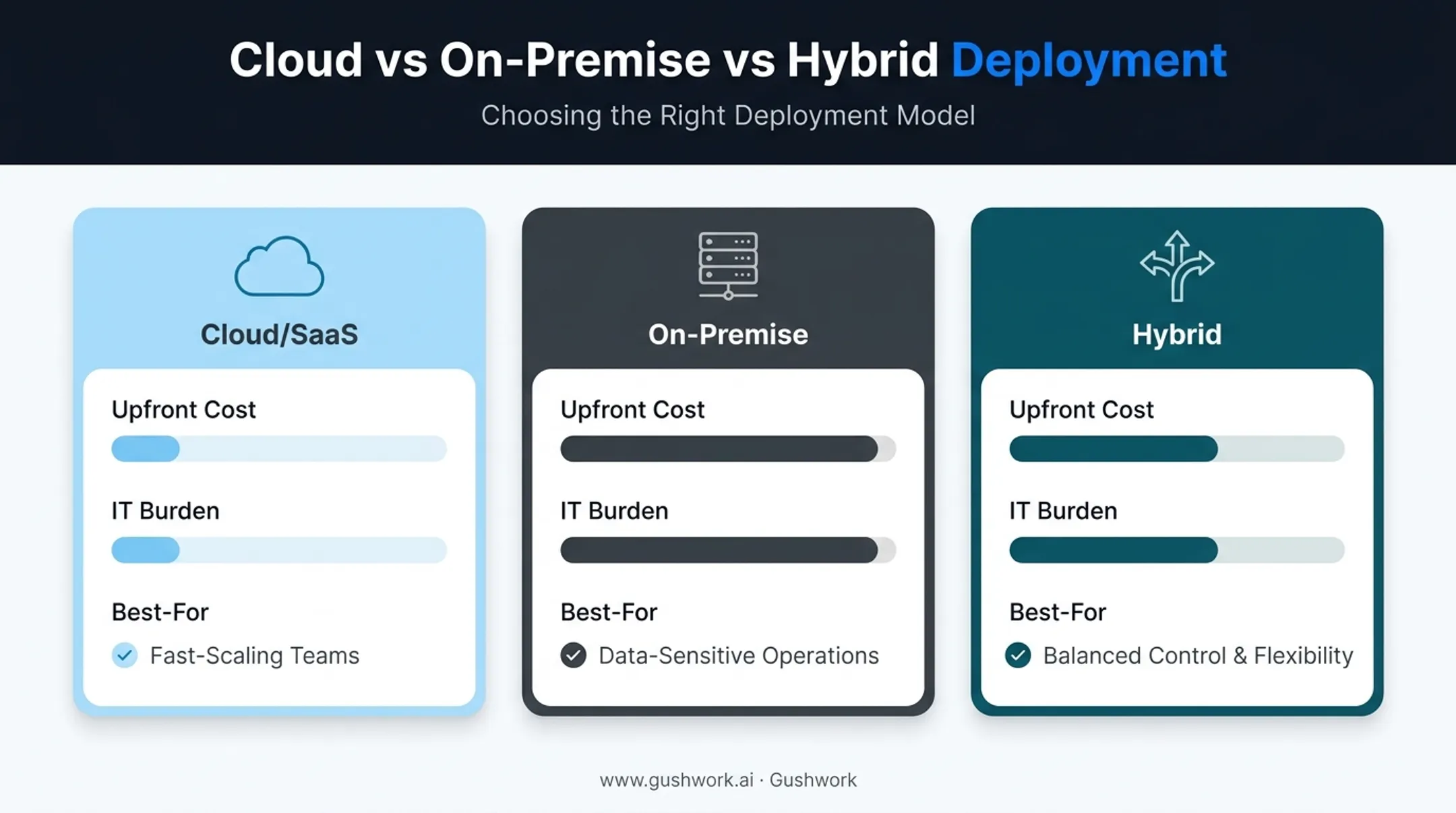

Deployment Model (Cloud vs On-Premise vs Hybrid)
Your deployment choice affects upfront capital cost, IT staffing needs, and how often you're forced into update cycles.
| Model | Upfront Cost | IT Burden | Best For |
|---|---|---|---|
| Cloud/SaaS | Low | Minimal — vendor manages updates | Fast-growing SMBs, elastic user counts |
| On-premise | High | High — internal team maintains everything | Companies with strict data residency needs |
| Hybrid | Moderate | Split responsibility | Staged migrations, regulated industries |

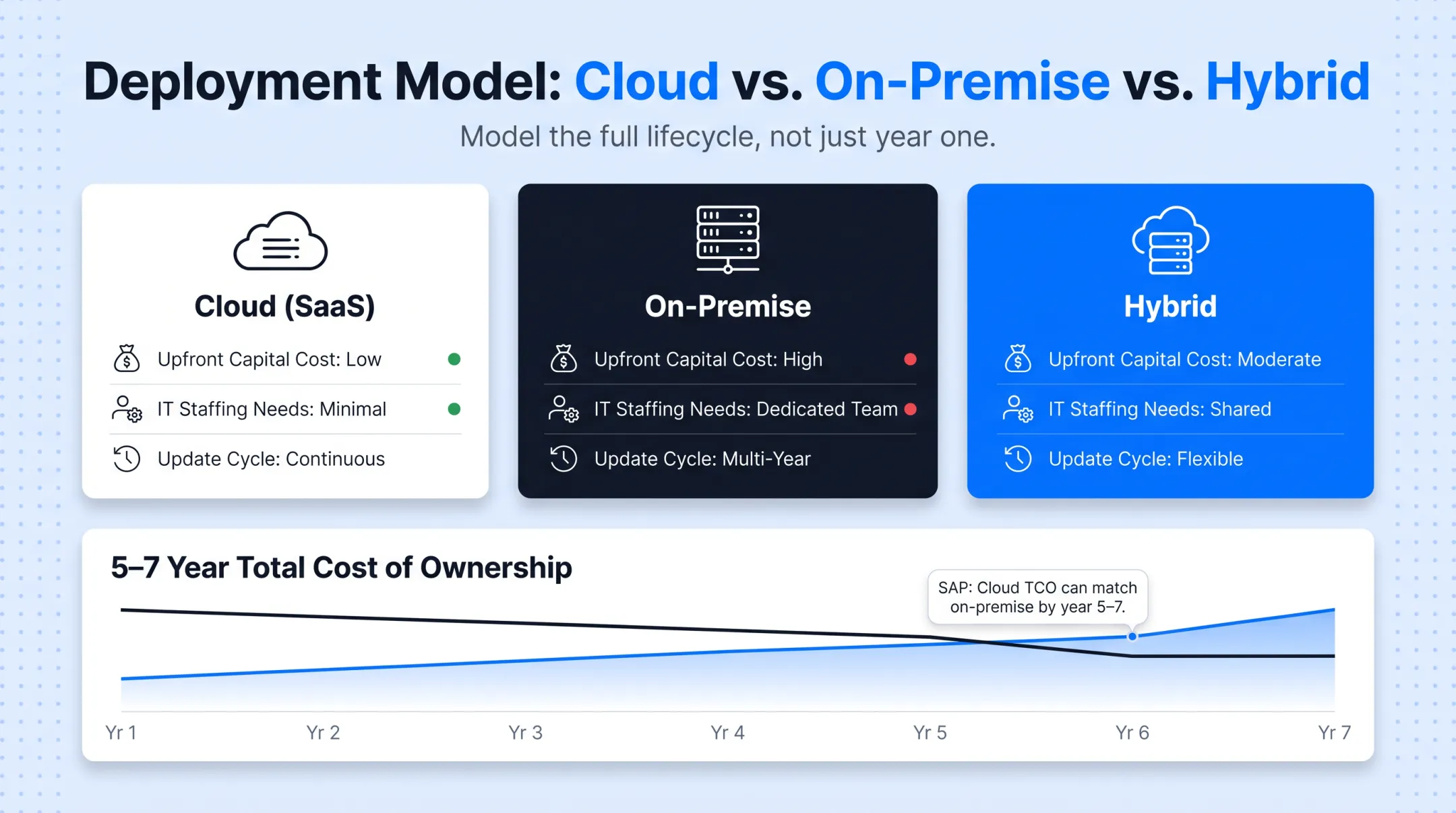

SAP notes that while cloud SaaS has little upfront cost, its five-to-seven-year TCO can end up similar to on-premise once recurring fees add up. Model the full lifecycle, not just year one.
User Experience & Change Management Readiness
The most technically sound ERP still fails if your team won't use it. Panorama's 2026 report shows organizational change management focus rising from 38.4% to 46.8% year over year — a sign more companies are recognizing this gap.
Build these checks into your selection scorecard:
- User adoption rate in the first 90 days post-launch
- Time to complete role-based training
- Size and length of productivity dips during cutover
If a vendor can't show how prior clients handled change management, treat that as a risk equal to any missing feature.
Common ERP Selection Mistakes to Avoid
Strong criteria still fall short when these pitfalls show up mid-process:
- Skipping stakeholder buy-in: rollout resistance often traces back to teams who were never consulted during selection
- Starting vendor demos too early: without a documented needs assessment, every demo looks impressive and none get compared fairly
- Underestimating ongoing costs: maintenance, customization, and support fees compound over years and often never make the initial budget

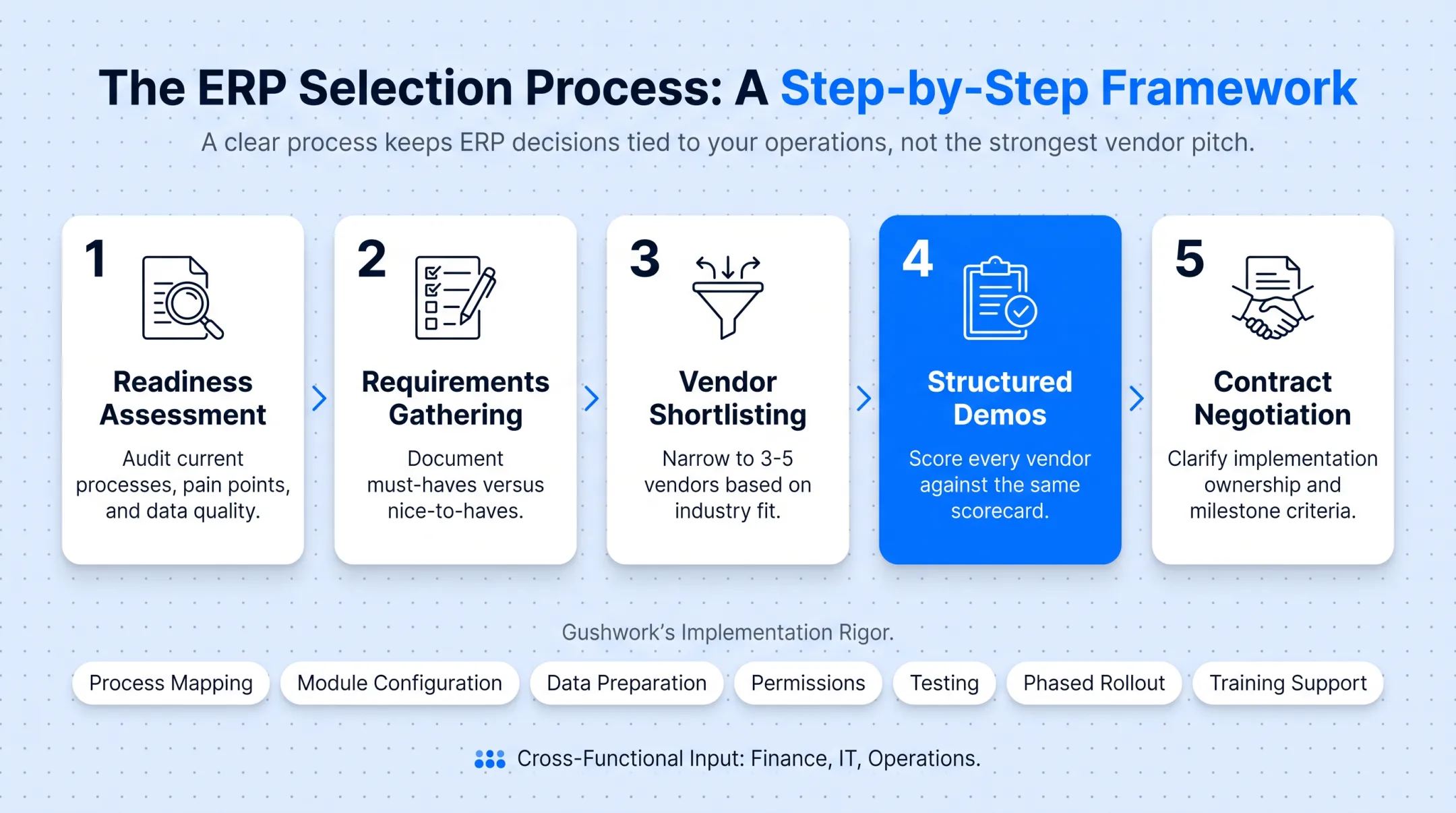

The ERP Selection Process: A Step-by-Step Framework

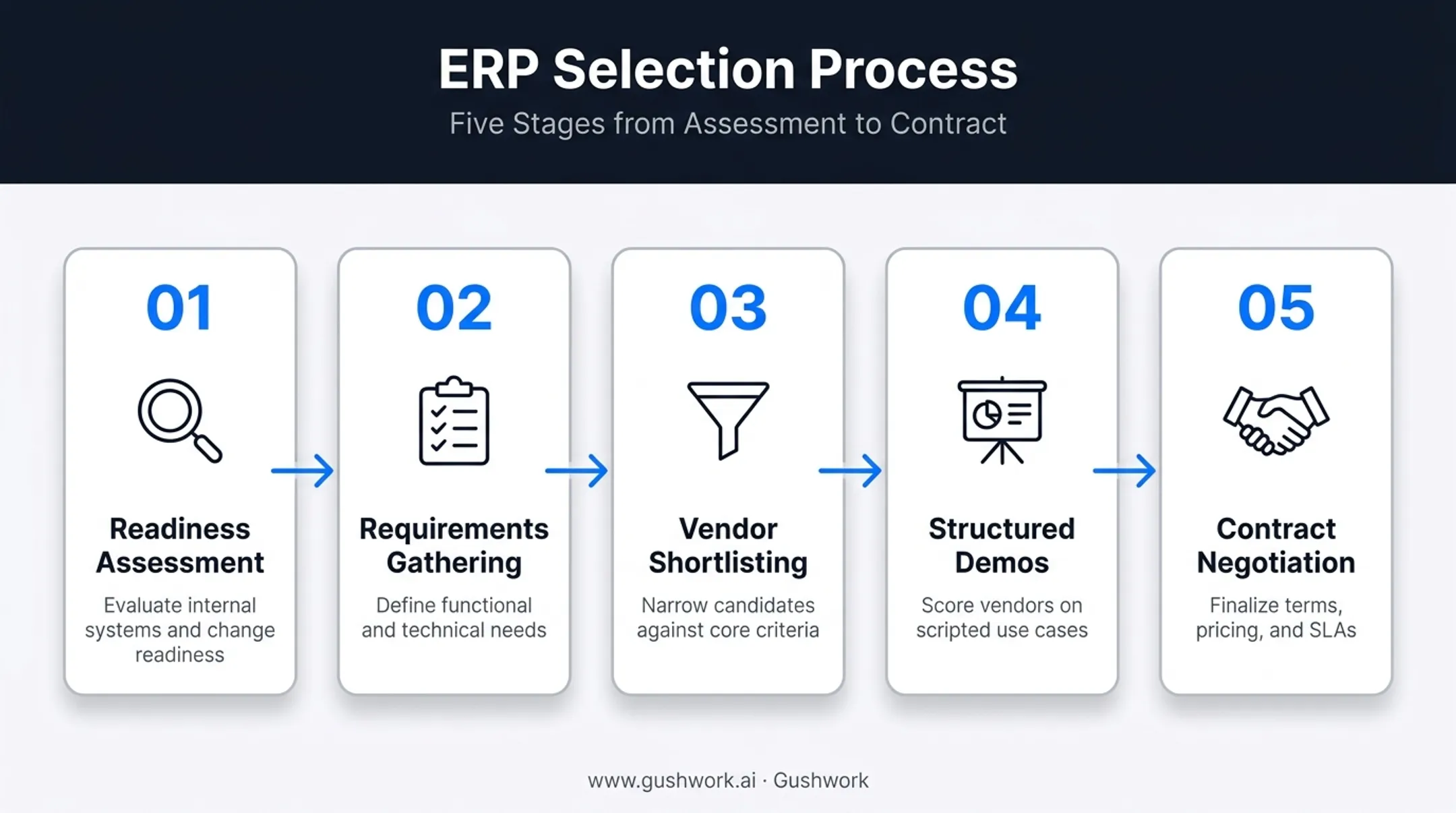

A clear process keeps ERP decisions tied to your operations, not the strongest vendor pitch. Work these five stages in order:
- Readiness assessment — audit current processes, pain points, and data quality before touching a vendor list
- Requirements gathering — document must-haves versus nice-to-haves across every department that touches the system
- Vendor shortlisting — narrow to 3-5 vendors based on industry fit and reference customers
- Structured demos — score every vendor against the same scorecard, using your real workflows, not their canned script
- Contract negotiation — clarify implementation ownership, milestone acceptance criteria, and change-order rules before signing

A standardized scorecard keeps vendor comparisons apples-to-apples instead of letting the best salesperson win. Involve finance, IT, and operations throughout — cross-functional input cuts costly missteps and builds the buy-in you need for adoption later.
When selection is disciplined, implementation stays on track. Gushwork’s ERP implementation work follows that same rigor: process mapping, module configuration, data preparation, permissions, testing, and phased rollout, with training support so adoption does not stall after go-live.
Conclusion
Choose fit over popularity. The right ERP matches your operational priorities and where your company is headed over the next few years.
ERP selection is a multi-year commitment. Treat it with the same rigor you'd apply to a major capital investment, not a snap decision made after three vendor demos. Once implemented, review performance periodically — data drift and process changes will eventually outpace what the system was originally configured to handle.
Selection is only the starting point. Keep revisiting configuration, integrations, and user adoption so the platform stays aligned as your operations scale.
Frequently Asked Questions
How do I select the right ERP system?
Start with a readiness assessment and requirements-gathering phase before contacting vendors. Then run structured, scorecard-based demos across your shortlist so you're comparing vendors on the same criteria, not their sales pitch.
What are the 7 steps of the supplier selection process?
Need identification, vendor research, RFP issuance, evaluation, negotiation, contract signing, and ongoing performance review. Each step builds on the last to reduce risk before you commit.
What are ERP vendors?
ERP vendors are software providers or implementation partners that build and support ERP platforms. They generally fall into Tier 1 (enterprise-scale), Tier 2 (mid-market), and industry-specific niche vendors.
What are the key ERP trends for 2026?
Gartner points to AI-driven automation, cloud-first adoption, and deeper industry-specific customization. Gartner also forecasts AI-enabled solutions will represent 62% of cloud ERP spending by 2027, up from just 14% in 2024.
How much does an ERP system typically cost?
License fees can range from roughly $80-$110 per user/month for mid-market platforms. However, implementation, data migration, and training typically make up the bulk of total cost of ownership.
How long does ERP implementation usually take?
Recent industry benchmarks show a median of around 9 months, but timelines vary widely by company size, module count, and data complexity. Some enterprise deployments run well over a year.
