Common CRM Implementation Challenges for Revenue Teams Most CRM rollouts don't fail because of the software. They fail because they expose problems that were already there: unclear revenue processes, messy data, no one owning key decisions, and teams working from different playbooks.

A CRM implementation touches everyone. Marketing needs attribution data. Sales needs clean pipeline visibility. Customer success needs handoff context. Finance needs forecast accuracy. When these teams have never agreed on shared definitions, the CRM just makes the disagreement visible faster.

This article walks through why CRM implementation is uniquely hard for revenue teams, the challenges that show up most often, and a phased approach to get it right the first time.

Key Takeaways

  • Treat CRM implementation as a revenue operating model project, not a software deployment
  • Define lifecycle stages, ownership, qualification criteria, and handoffs before configuring anything
  • Prioritize clean data and phased rollout over feature completeness
  • Measure adoption and outcomes continuously, not just at launch

Why CRM Implementation Is Uniquely Difficult for Revenue Teams

CRM implementation crosses the full revenue lifecycle

A CRM record gets touched by marketing, sales, customer success, finance, and RevOps. Each team wants something different from it. Marketing needs source and campaign data. Sales needs qualification status. Customer success needs onboarding milestones. Finance needs billing status. RevOps needs clean handoffs and consistent stage data.

Before configuring anything, map both journeys together:

  • Buyer journey: awareness, evaluation, purchase, onboarding, renewal
  • Seller journey: lead capture, qualification, opportunity creation, close, handoff, expansion

If these two maps don't align at each handoff point, the CRM will just automate the confusion.

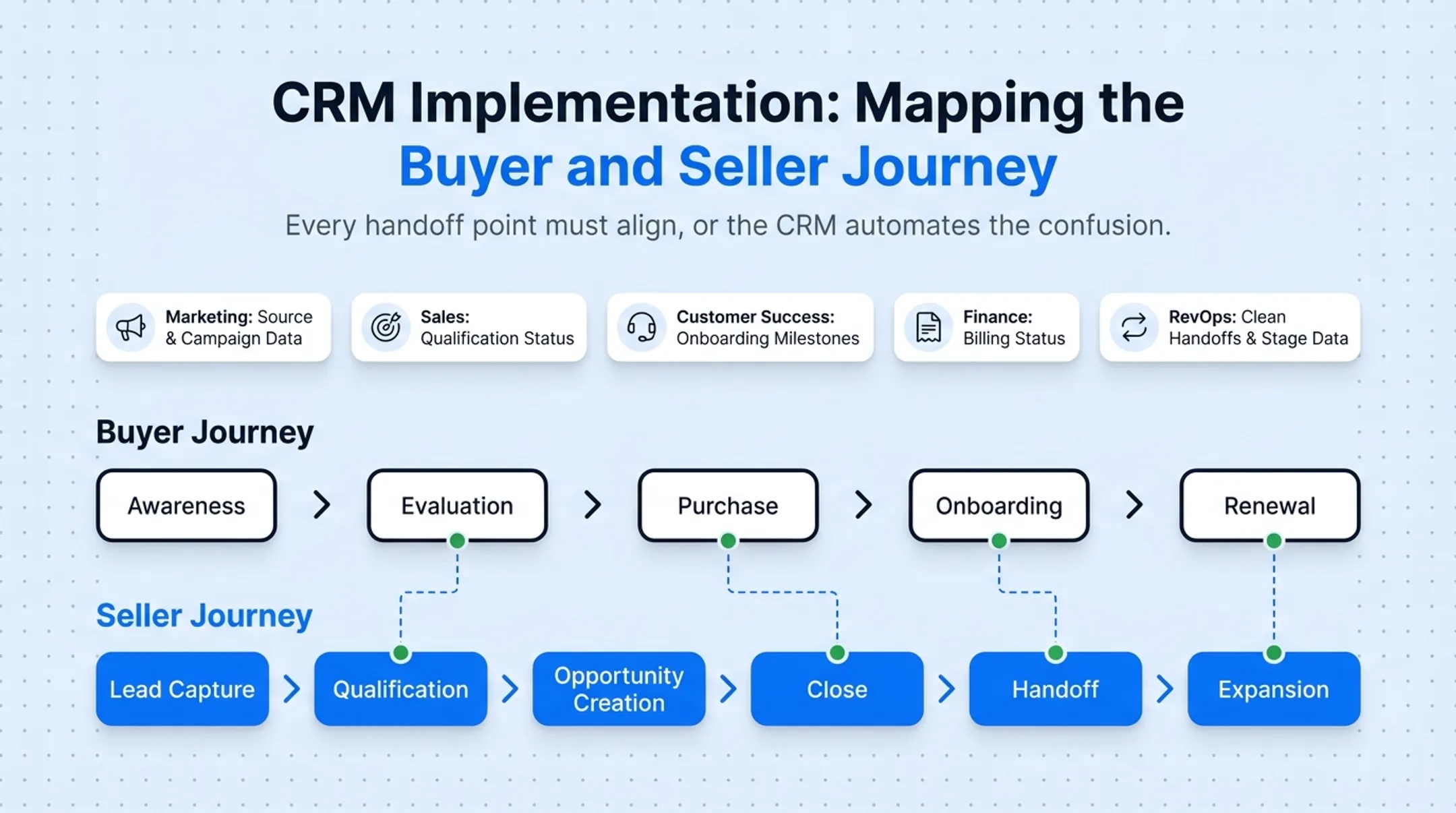

Buyer journey and seller journey alignment map with handoff points

Shared definitions are the foundation of a reliable CRM

What counts as a "lead"? An "MQL"? A "closed-won" deal? If marketing and sales answer differently, your reporting will never reconcile.

Document, for every stage:

  • Entry and exit criteria
  • Field ownership (who updates what)
  • Required fields before a record can move forward

This sounds basic. Teams skip it anyway, then wonder why pipeline reports don't match reality.

Poor implementation reduces trust in revenue data

This isn't a small problem. Salesforce's 2024 State of Sales survey found that only 35% of sales professionals completely trust the accuracy of their organization's data.

Reps also spend roughly 9% of their workweek manually entering customer information because systems don't talk to each other.

When trust in the data drops, so does forecast reliability, follow-up speed, and attribution accuracy: the exact outcomes a CRM is supposed to improve.

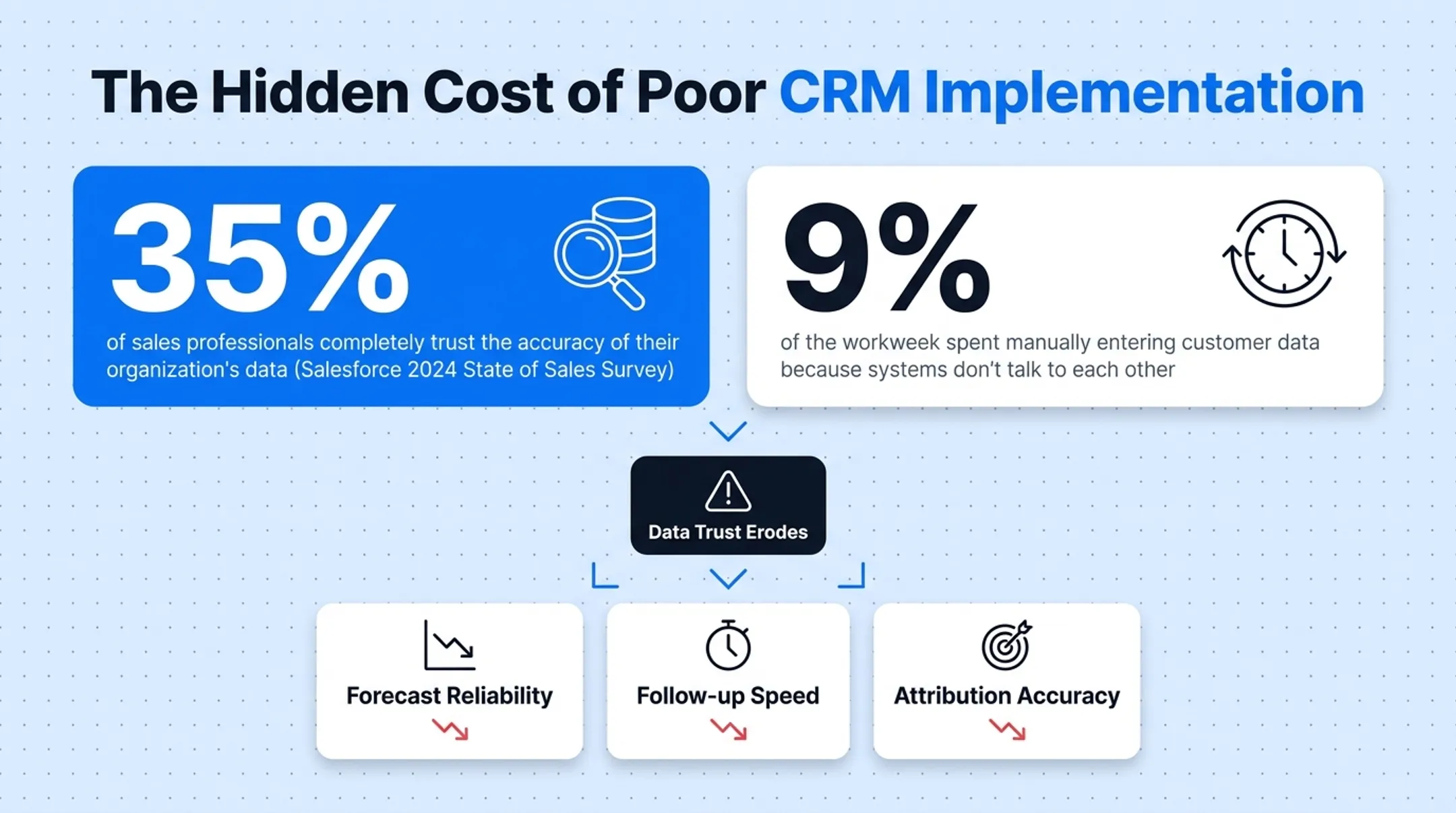

Sales data trust and manual entry statistics impacting CRM reliability

Common CRM Implementation Challenges for Revenue Teams

Unclear goals, weak sponsorship, and process misalignment

"Improve sales" isn't a goal you can build a CRM around. Vague objectives make it impossible to prioritize features or measure ROI afterward.

Before you configure anything:

  • Secure an executive sponsor who will enforce adoption, not just approve the budget
  • Gather requirements across marketing, sales, and customer success — not just from IT
  • Set measurable outcomes (lead response time, forecast variance, handoff completion)
  • Watch for the trap of digitizing a broken process instead of fixing it first

Data migration problems and poor data quality

Duplicate records, inconsistent account names, incomplete contacts, and lost source attribution are the norm in legacy systems, not the exception.

Microsoft classifies migration complexity by volume: simple migrations run under 1 GB or fewer than 50,000 records, while complex ones exceed 50 GB or 500,000 records. Each tier carries proportionally higher risk of errors.

Before full migration:

  1. Run a pre-migration data audit
  2. Build a data dictionary defining every field
  3. Set deduplication rules
  4. Back up the source system
  5. Run a sample migration and validate with actual users
  6. Only then migrate the full dataset

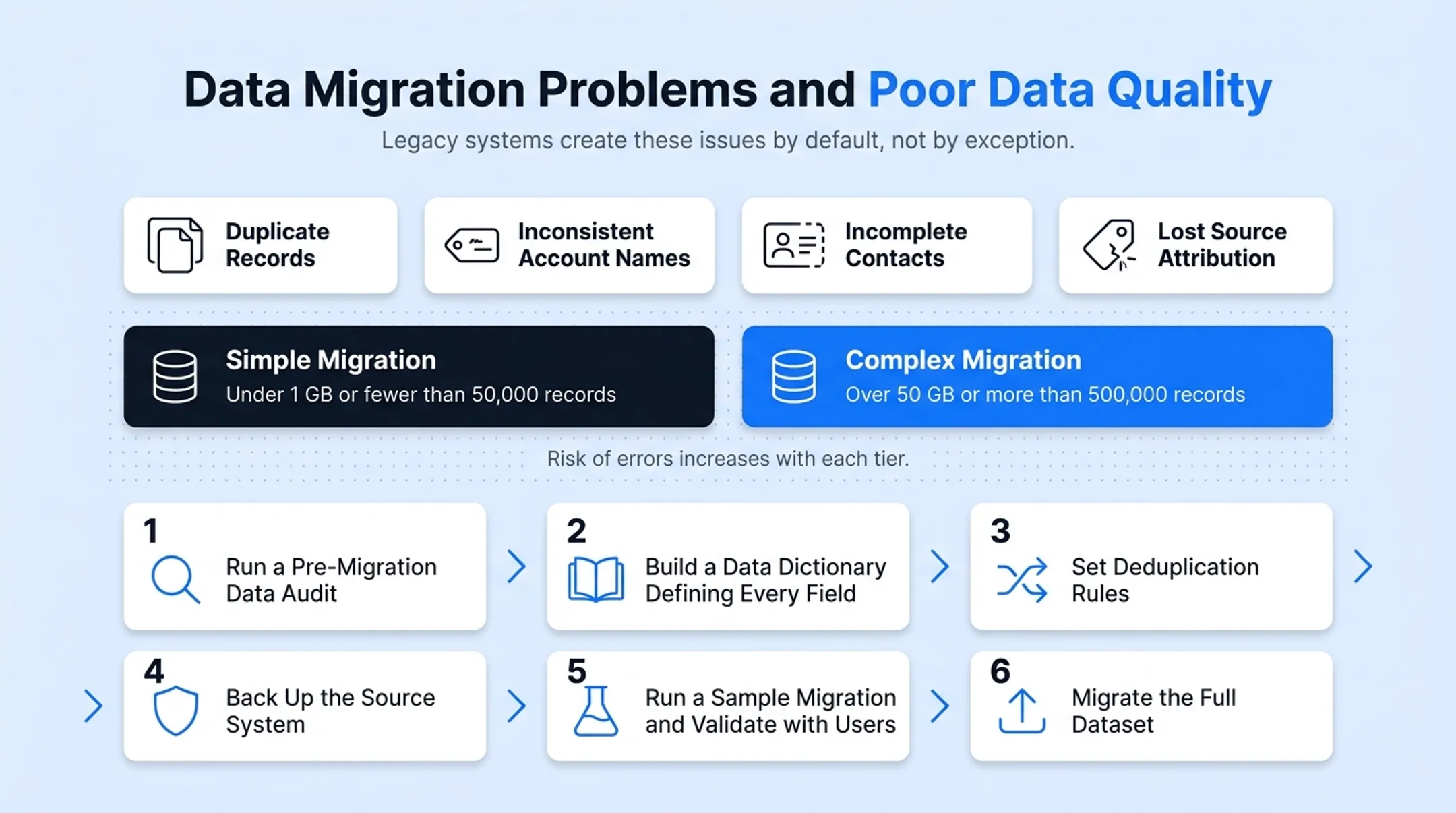

Six-step CRM data migration process from audit to full dataset transfer

Resistance to change and low user adoption

Reps often see CRM data entry as administrative overhead or surveillance, not a tool that helps them sell. Salesforce's own CRM Adoption Guide names resistance to digital transformation as a core implementation risk.

Fix it by:

  • Involving frontline users in requirements gathering, not just leadership
  • Running role-specific training instead of one generic session
  • Naming CRM champions on each team
  • Requiring leadership to actually use the CRM in pipeline reviews
  • Building a real feedback channel that resolves usability complaints

Integration failures and broken revenue handoffs

CRMs rarely operate alone. They connect to marketing automation, email, calendars, billing, support tools, and enrichment platforms. When those connections break, so do the handoffs between teams.

Salesforce and MuleSoft's 2025 Connectivity Benchmark found that 95% of IT leaders struggle to integrate data across systems, and on average only 29% of enterprise applications are actually connected.

Before building automation on top of integrations, define:

  • Field ownership (which system is the source of truth for each field)
  • One-way versus two-way sync
  • Error handling and duplicate prevention rules
  • A testing plan before go-live

Security, scope, budget, and governance gaps

Excessive permissions, weak authentication, and unreviewed third-party access create real exposure. Microsoft's Dynamics 365 security guidance places responsibility on the customer for data classification, identity management, and role-based security. None of that happens by default.

Underfunded training, unrealistic timelines, and unchecked customization requests make scope creep almost guaranteed. Lock it down with:

  • Role-based access controls
  • Vendor security reviews
  • Documented change control
  • A named owner for ongoing maintenance

How to Prevent and Solve CRM Implementation Challenges

Start with a revenue operating blueprint

Before touching the platform, document:

  • Target customers and lifecycle stages
  • Qualification rules and pipeline stages
  • Ownership at every stage
  • Service-level expectations for handoffs
  • Post-sale milestones

Build this around how your revenue team actually needs to work, not how the last system happened to be set up.

Define success metrics and establish baselines

Pick a small set of metrics and record where you stand today before launch:

  • Lead response speed
  • Stage conversion rates
  • Data completeness
  • Pipeline aging
  • Forecast variance
  • Handoff completion rate

Forecast accuracy is worth watching closely. Gartner notes that only 7% of sales teams hit 90%+ forecast accuracy, with median accuracy sitting between 70-79%. A well-implemented CRM should move that number, not just report it.

Design data and integration architecture before building automation

Before automation goes live, lock down the data foundation:

  • Name the source of truth for every major data type
  • Standardize field definitions across systems
  • Map account-to-contact relationships
  • Define deduplication logic

Organic acquisition data needs extra care. When leads enter the CRM, retain source, campaign, landing-page, and intent context. Without it, attribution reporting breaks as soon as marketing tries to prove what is working. Teams running SEO-driven lead gen (including B2B manufacturers and industrial suppliers using programs like Gushwork's) especially need that upstream context preserved so pipeline impact stays visible.

Configure for usability instead of maximum feature coverage

Usability beats packing in more fields and automation.

  • Limit required fields to what's operationally necessary
  • Remove redundant screens
  • Build role-specific dashboards
  • Keep pipeline stages simple
  • Automate repetitive updates only after the manual process is proven
  • Test mobile usability; field sales teams live on their phones

Over-customization sinks CRM projects. Every extra field or workflow is something to maintain forever.

Build change management into the implementation plan

Technology adoption is a people problem first. Build these into the plan:

  • Stakeholder communication before launch
  • Role-based enablement, not generic training
  • Hands-on practice with realistic scenarios
  • Internal champions and office hours
  • Searchable documentation
  • A formal process to collect and prioritize feedback

Leaders reinforce usage simply by relying on CRM data in their own meetings. If leadership still asks for a spreadsheet, nobody else will trust the CRM either.

A Phased CRM Implementation Plan for Revenue Teams

Most CRM failures trace back to rushing configuration before teams agree on process, data, and ownership. A five-phase rollout keeps revenue workflows stable while you build adoption.

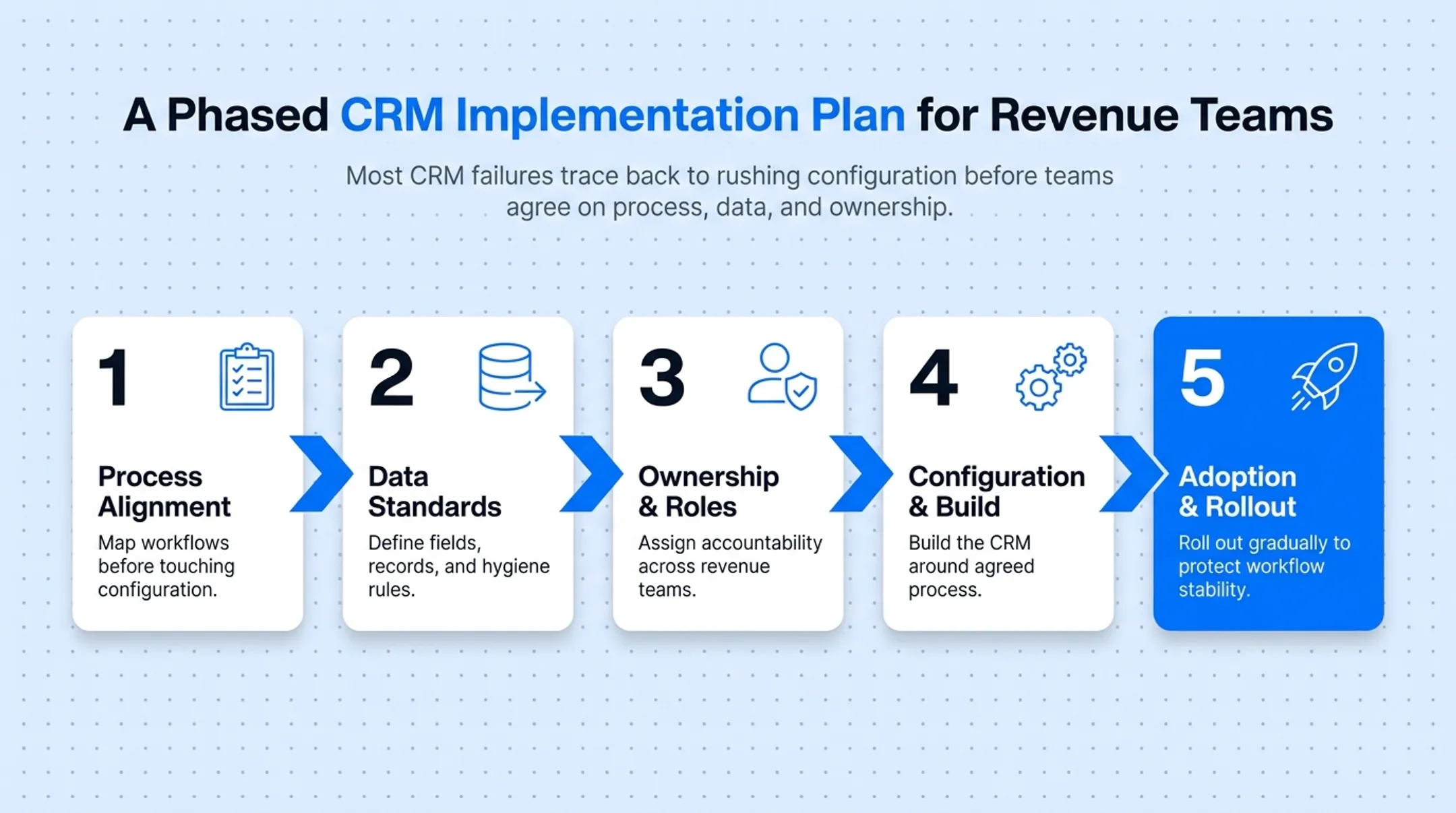

Five-phase CRM implementation rollout plan for revenue teams

Phase one: discover, align, and define

Run discovery workshops across marketing, sales, customer success, finance, and operations. Lock in:

  • Agreed terminology and process maps
  • Ownership rules and business objectives
  • Required integrations
  • A prioritized capability list

Phase two: prepare data and configure the foundation

Build the foundation before go-live:

  • Data inventory, cleansing, and field mapping
  • Permissions, pipeline configuration, and lead routing
  • Validation rules that keep records clean

Skip migrating inactive or unnecessary historical data. It only adds noise.

Phase three: pilot and validate with real revenue scenarios

Select a representative pilot group and test real workflows:

  • Inbound lead assignment
  • Opportunity progression
  • Stalled-deal follow-up
  • Sales-to-onboarding handoffs
  • Account updates from connected systems

Run user acceptance testing, data reconciliation, and integration error testing before wider rollout.

Phase four: launch in controlled waves and provide hypercare

Roll out by team or workflow instead of activating everything at once. Support each wave with:

  • Launch communications
  • Temporary support coverage
  • Daily feedback collection
  • Clear criteria for expanding beyond the pilot group

Phase five: govern, measure, and improve after go-live

Assign ongoing ownership for administration, data quality, permissions, integrations, and training. Review adoption quality, data health, and forecast usefulness on a fixed cadence, and keep a documented process for resolving recurring issues.

Conclusion: Build the Revenue System Before Automating It

The hardest CRM implementation problems usually aren't technical. They're symptoms of unclear processes, inconsistent definitions, and change management that got skipped to hit a launch date.

Before you go live, make sure you've:

  • Defined stages, owners, and handoffs—not just the software configuration
  • Involved end users from day one
  • Migrated only trusted, clean data
  • Tested every critical handoff
  • Launched in phases, not all at once
  • Funded governance for after launch, not just the rollout

Go live only after that foundation is in place—and judge success by pipeline velocity, forecast accuracy, and adoption, not by whether the software shipped on time.

Frequently Asked Questions

What are the risks of CRM implementation?

Key risks include data loss or corruption, low adoption, integration failures, security exposure, cost overruns, and unreliable revenue reporting. Phased testing, governance, and clear ownership significantly reduce these risks.

Is Microsoft Teams a CRM tool?

No. Microsoft Teams is a collaboration and communication platform, not a CRM. It can integrate with CRM systems to support collaboration, but it doesn't replace customer records, pipeline management, or CRM reporting.

How long does CRM implementation take?

Timing depends on data complexity, integrations, customization, and rollout scope. Salesforce notes small-business implementations can take just a few weeks, while larger, integration-heavy projects often take several months.

How do you get revenue teams to adopt a new CRM?

Involve users early, build role-specific workflows, keep data entry simple, and provide practical training. Naming CRM champions and having leadership actually use the system in meetings drives adoption faster than mandates.

What data should be migrated into a CRM?

Migrate accurate, operationally useful records and their related history, while cleansing duplicates and archiving what's no longer needed. Pay attention to field mapping, consent data, account relationships, and source attribution.

How can you measure CRM implementation success?

Track both adoption quality and revenue outcomes: data completeness, lead-routing accuracy, handoff completion, pipeline visibility, and forecast usefulness compared against your pre-implementation baseline.
