Switch Real Estate CRMs Without Losing Leads Switching CRMs is risky for one reason: you're not just moving contacts. You're moving context — the reminders, routing rules, and follow-up history that turn a name into a closed deal. Lose that, and you've lost the lead even if the name still shows up in a spreadsheet.

A real migration is a controlled project: data inventory, backups, field mapping, workflow rebuilding, testing, and team adoption. It's not exporting a CSV and hoping for the best.

This guide walks through deciding whether to switch, protecting active leads, moving data safely, rebuilding automations, running a clean cutover, and validating the new system before you cancel the old one.

Key Takeaways

  • Protect migration-critical data: active leads, open deals, follow-ups, notes, consent, and lead sources
  • Back up and export the old CRM before canceling anything, then test a small sample before the full import
  • Rebuild your highest-value lead-response workflows before routing new inquiries into the new CRM
  • Run a controlled overlap period with one designated system for new records and a firm cutover date

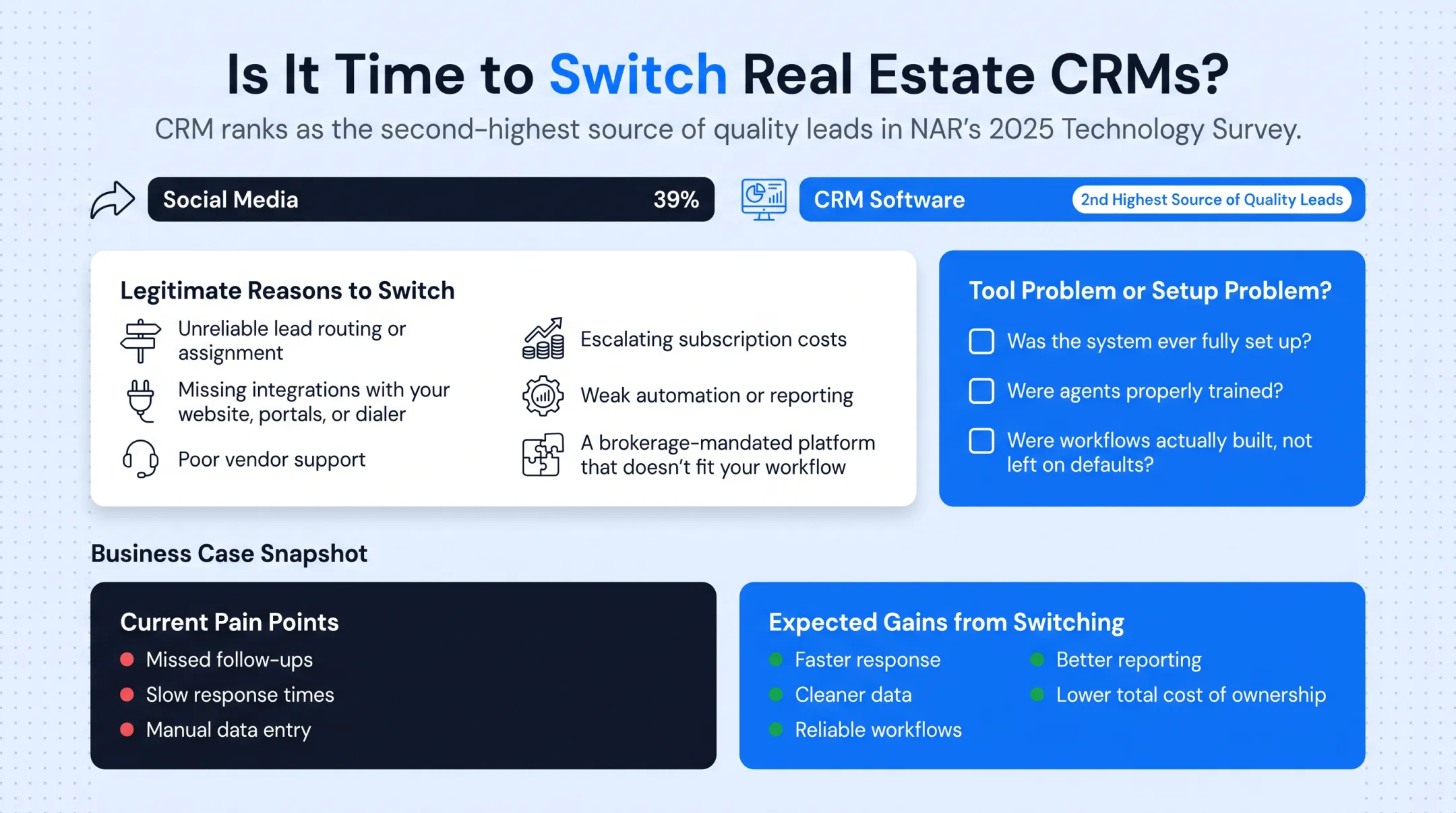

Is It Time to Switch Real Estate CRMs?

CRM technology isn't optional in this business. NAR's 2025 Technology Survey ranked CRM the second-highest source of quality leads, behind only social media at 39%. If your CRM isn't pulling its weight, that's a real cost.

Legitimate reasons to switch include:

  • Unreliable lead routing or assignment
  • Missing integrations with your website, portals, or dialer
  • Poor vendor support
  • Escalating subscription costs
  • Weak automation or reporting
  • A brokerage-mandated platform that doesn't fit your workflow

Before you blame the software, ask a harder question: is this a tool problem or a setup problem? Many CRMs get blamed for failures that trace back to incomplete configuration or inconsistent team use. Check whether the current system was ever fully set up, whether agents were trained, and whether workflows were actually built — not just left on defaults.

Build a short business case. Compare your current recurring problems (missed follow-ups, slow response times, manual data entry) against the expected gains from switching: faster response, cleaner data, more reliable workflows, better reporting, and lower total cost of ownership. If the numbers don't clearly favor a change, fix the configuration first.

Decision checklist comparing CRM tool problems versus setup problems

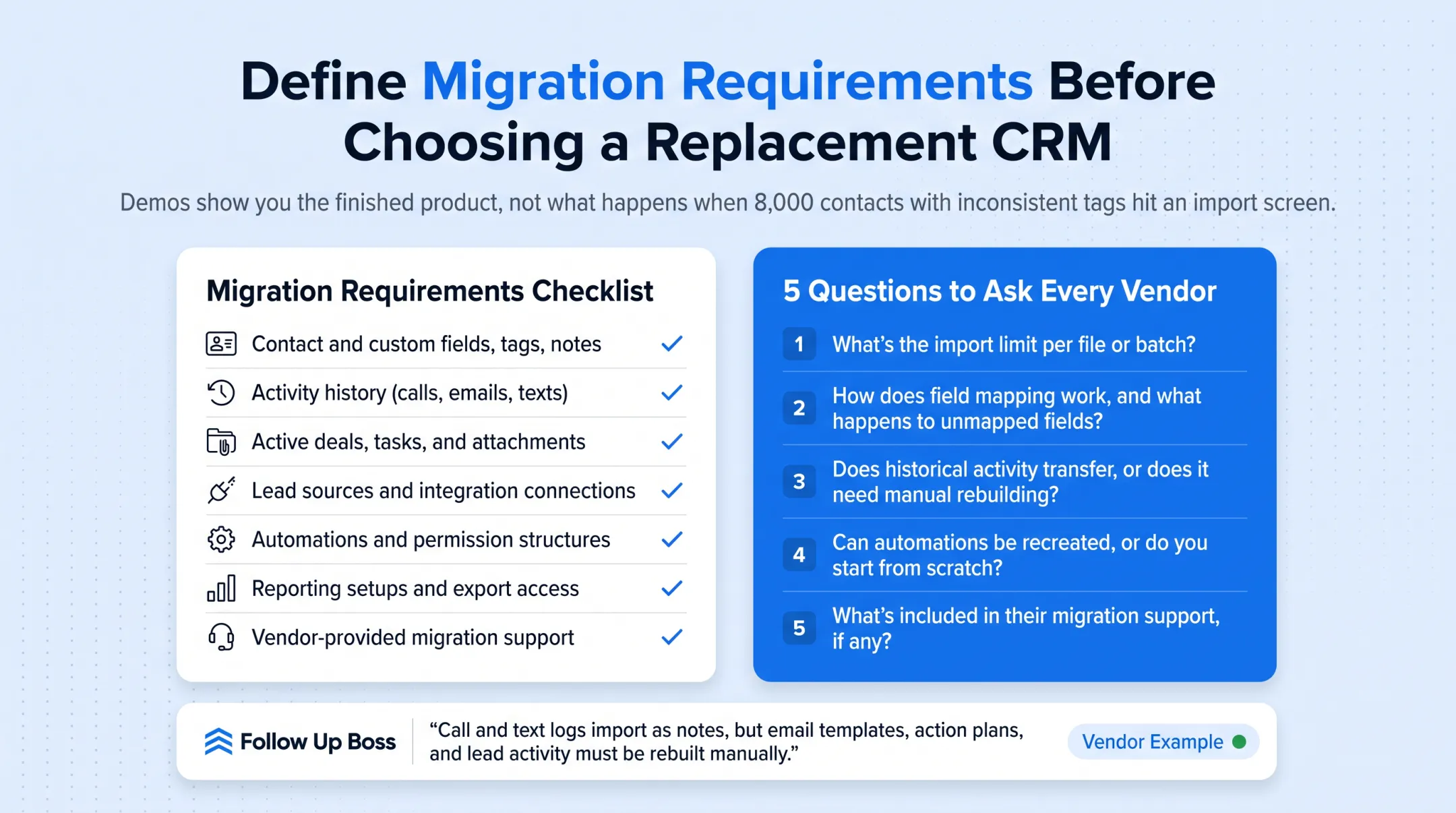

Define Migration Requirements Before Choosing a Replacement CRM

Before you shop for a new CRM, write down what has to survive the move. This checklist becomes your evaluation criteria.

Migration requirements checklist:

  • Contact and custom fields, tags, notes
  • Activity history (calls, emails, texts)
  • Active deals, tasks, and attachments
  • Lead sources and integration connections
  • Automations and permission structures
  • Reporting setups and export access
  • Vendor-provided migration support

Don't judge a replacement CRM by its demo. Demos show you the finished product, not what happens when 8,000 contacts with inconsistent tags hit an import screen. Ask vendors directly:

  1. What's the import limit per file or batch?
  2. How does field mapping work, and what happens to unmapped fields?
  3. Does historical activity transfer, or does it need manual rebuilding?
  4. Can automations be recreated, or do you start from scratch?
  5. What's included in their migration support, if any?

Follow Up Boss, for example, documents its migration limits in public help docs: call and text logs import as notes, but email templates, action plans, and lead activity must be rebuilt manually. That's the specificity you need from any vendor before you sign.

Five vendor questions checklist before choosing a replacement real estate CRM

If this CRM switch is part of a larger lead-generation reset, treat that as a separate workstream from migration. Gushwork helps businesses build organic search visibility and generate qualified leads through AI-driven SEO—a complementary need, not a CRM migration service.

Move and Validate Your CRM Data

Before you export a single record, audit what you actually have.

Document these before touching anything:

  • Total records, active leads, and open transactions
  • Pipeline stages, lead sources, and record owners
  • Tags, custom fields, automations, and integrations
  • Consent records and any data requiring special handling

Build a Lead-Priority Inventory

Not every record deserves the same urgency. Separate your database into:

  • Active opportunities and open transactions
  • New inquiries and warm leads
  • Past clients and referral partners
  • Long-term nurture contacts
  • Inactive or questionable records

This ordering matters later — it determines what gets migrated and checked first.

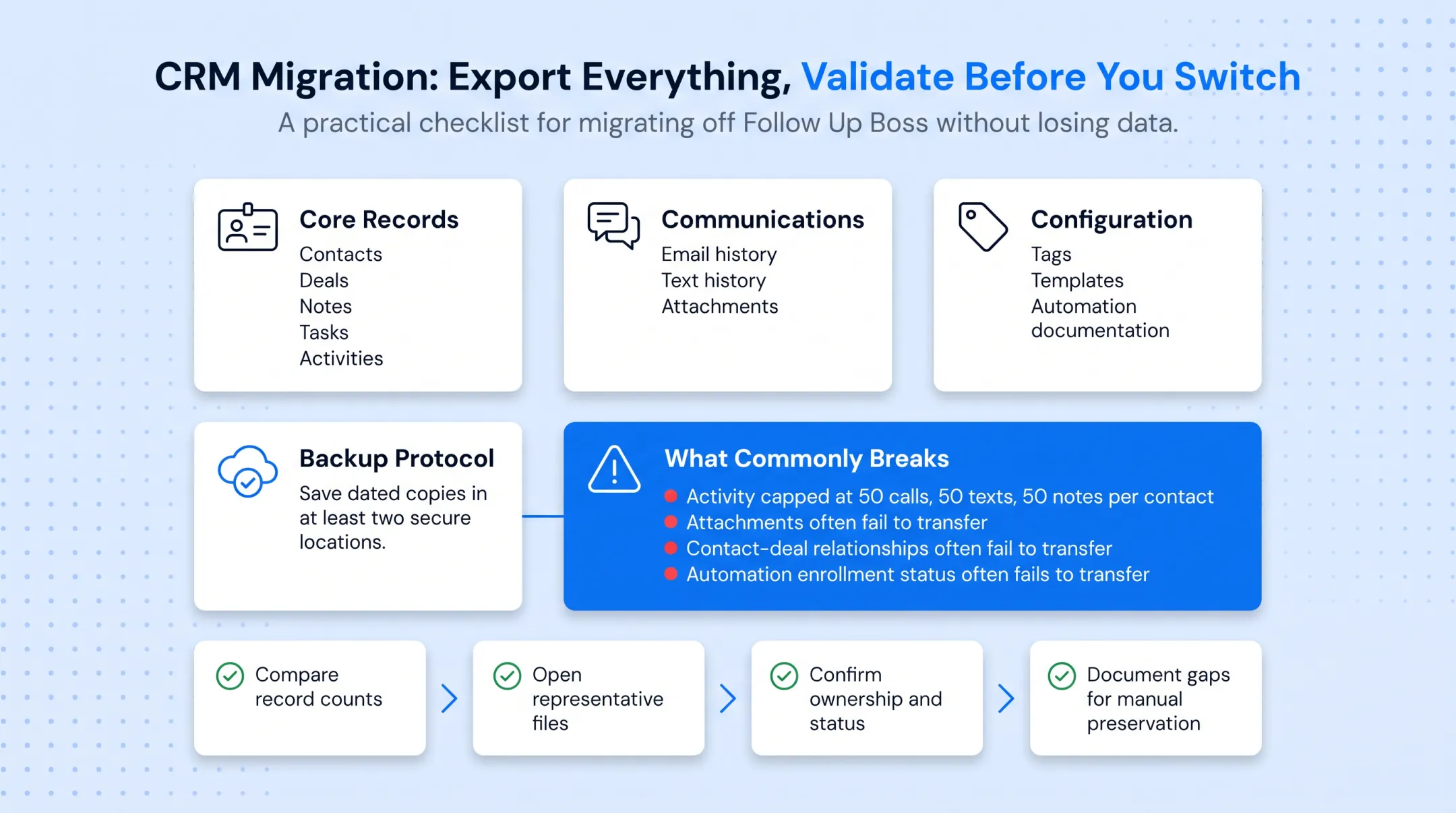

Export Everything Separately

Export each data type as its own file:

  • Contacts, deals, notes, tasks, and activities
  • Email history, text history, and attachments
  • Tags, templates, and automation documentation

Save dated copies in at least two secure locations.

Be realistic about what commonly breaks. Follow Up Boss's export documentation caps activity history at the most recent 50 calls, 50 texts, and 50 notes per contact — anything older is left out. Attachments, contact-deal relationships, and automation enrollment status often fail to transfer cleanly too.

Validate before you change anything:

  • Compare record counts between source and export
  • Open representative files and check required fields
  • Confirm ownership and status values transferred correctly
  • Document any gaps that will need manual preservation

CRM data export and validation workflow from inventory to migration

Clean, Map, and Import Records Into the New CRM

Don't import garbage into a clean system. Clean first:

  • Remove duplicates and invalid contact details
  • Archive obsolete or abandoned test records
  • Standardize inconsistent phone and address formats
  • Flag contacts with no usable next action

Build a Field-Mapping Document

For every field, document the old field name, new field name, data type, transformation rule, owner, and validation method.

Watch these fields closely—they are the ones most likely to get mangled in translation:

  • Lead source
  • Property interest
  • Buyer/seller status
  • Timeline and budget
  • Referral source
  • Consent data

Configure Before You Import

Set up the new CRM's users, permissions, pipeline stages, tags, custom fields, lead-source values, required fields, and notification rules before loading any records. Importing into an unconfigured system just moves the mess.

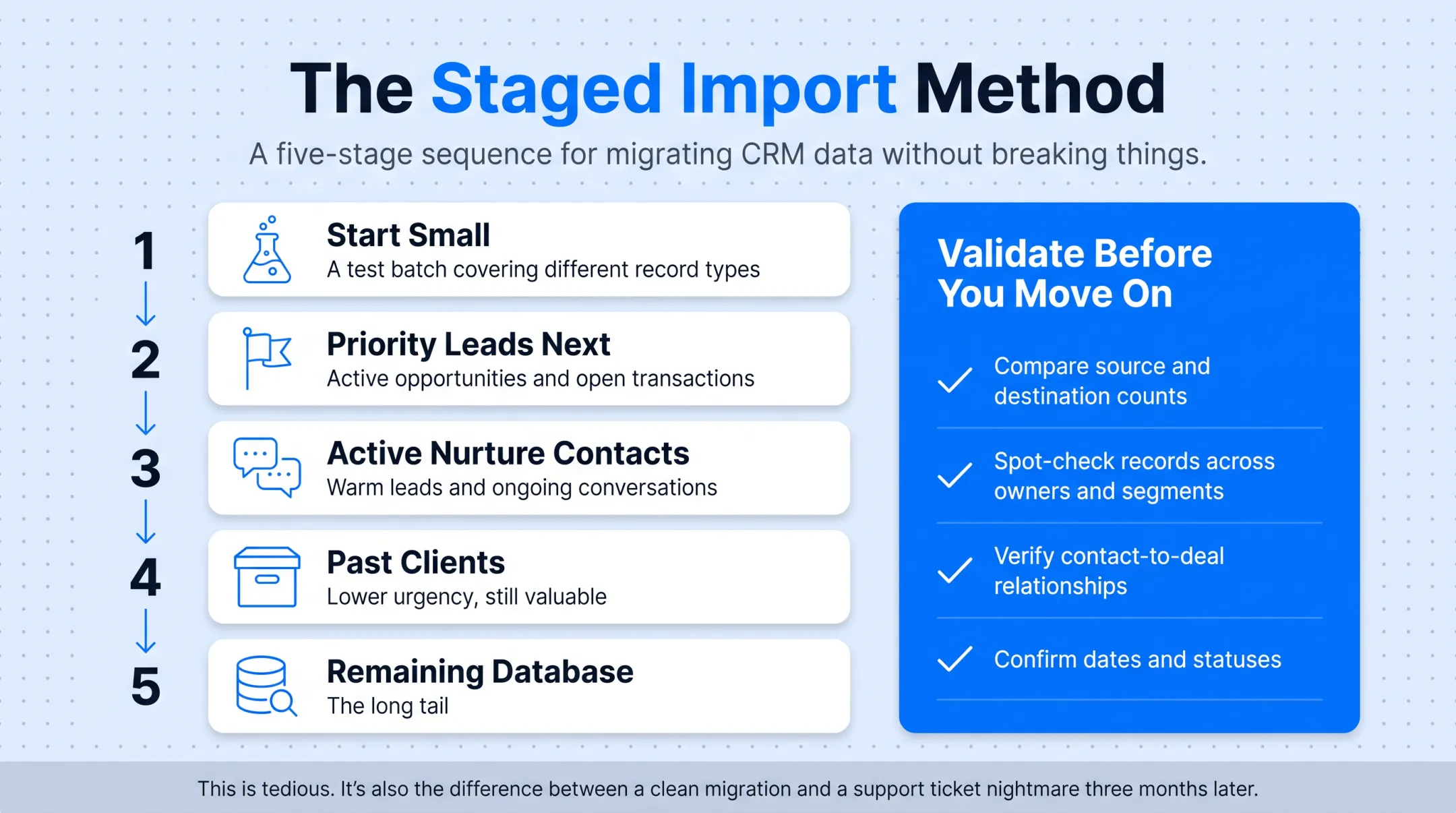

Use a Staged Import

  1. Start small — a test batch covering different record types
  2. Priority leads next — active opportunities and open transactions
  3. Active nurture contacts — warm leads and ongoing conversations
  4. Past clients — lower urgency, still valuable
  5. Remaining database — the long tail

After each stage, validate before you move on:

  • Compare source and destination counts
  • Spot-check records across owners and segments
  • Verify contact-to-deal relationships
  • Confirm dates and statuses

Staged CRM import process from test batch to full database migration

This is tedious. It's also the difference between a clean migration and a support ticket nightmare three months later.

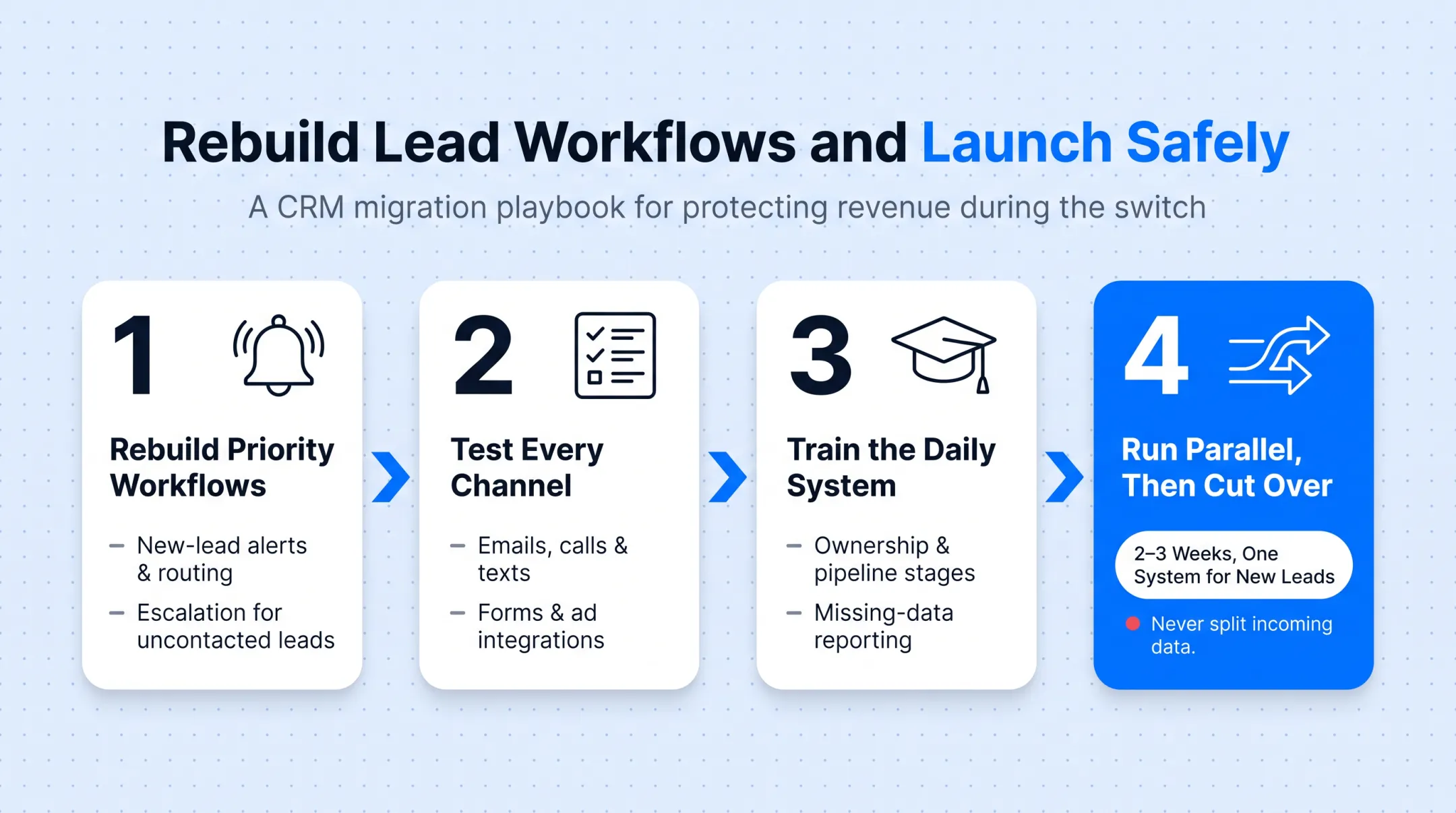

Rebuild Lead Workflows and Launch Safely

Automations don't transfer cleanly between platforms — accept that now. Rebuild the workflows that directly protect revenue first:

  • New-lead alerts and immediate response tasks
  • Lead assignment and routing rules
  • Appointment reminders
  • Active-deal follow-ups
  • Nurture sequences
  • Escalation rules for uncontacted leads

Don't copy every old automation blindly. Review each trigger, delay, condition, message, owner, and exit rule individually. Old workflows collect clutter over time: duplicate outreach, stale tasks, and irrelevant messages. A migration is your chance to cut that dead weight, not preserve it.

Test everything with internal records before going live:

  • Emails, calls, and texts
  • Forms and website lead capture
  • Calendar connections and advertising integrations
  • Notifications and consent handling

One bad test is better than one lost buyer.

Train your team on the daily system of record: where new leads land, how ownership gets assigned, how follow-ups get logged, how pipeline stages update, and how to report missing data.

Run both systems in parallel for a defined window. Follow Up Boss recommends roughly 2–3 weeks for this transition, with daily check-ins to catch issues early.

Route all new leads into one designated system during this period. Keep the old platform available for historical lookup, but never let both systems accept new data at the same time. That split is how duplicate records happen.

Parallel CRM run period timeline with single lead routing system

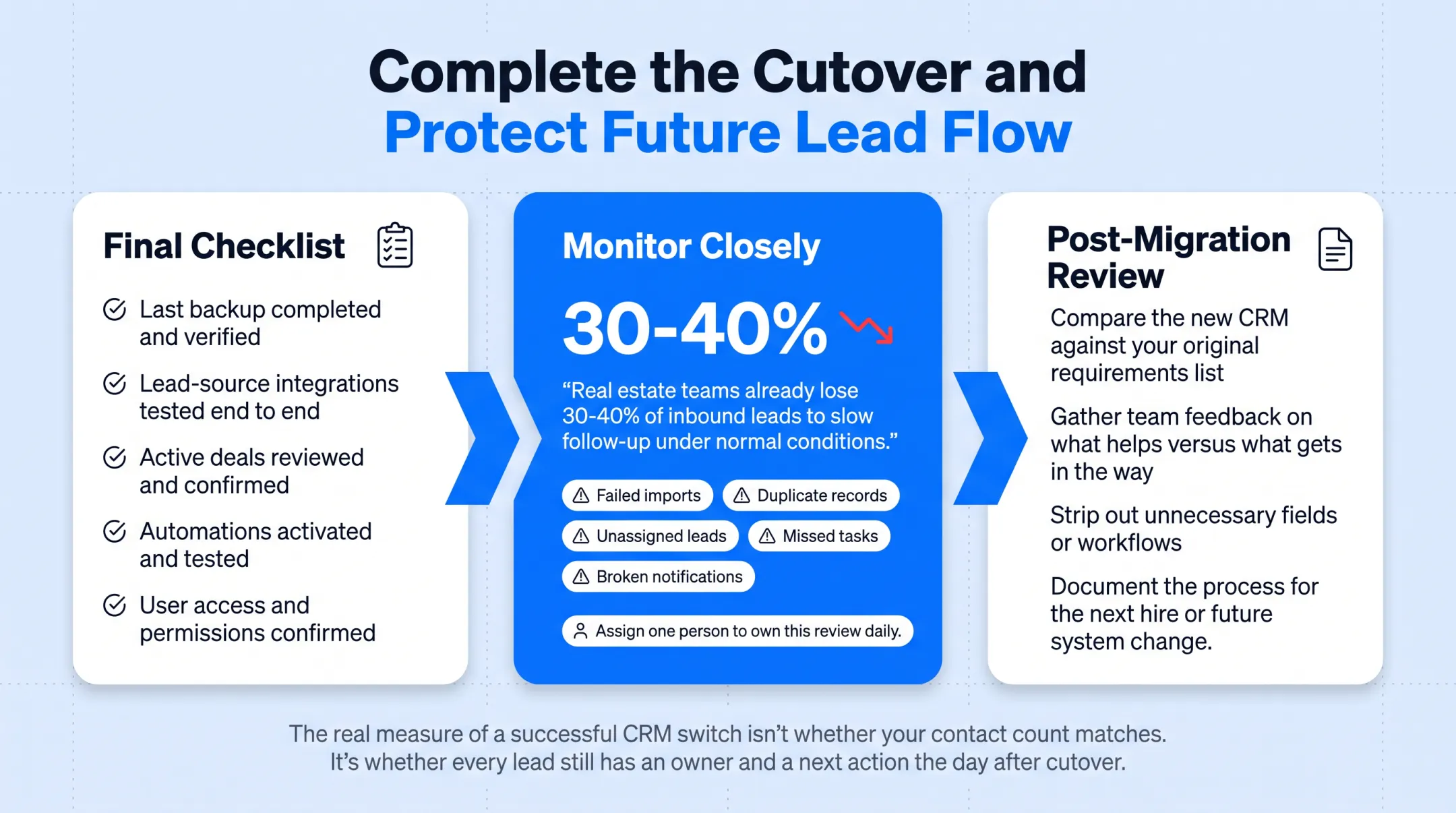

Complete the Cutover and Protect Future Lead Flow

Before you flip the switch permanently, run through a final checklist:

  • Last backup completed and verified
  • Lead-source integrations tested end to end
  • Active deals reviewed and confirmed
  • Automations activated and tested
  • User access and permissions confirmed
  • Data permissions and integration status verified
  • Every high-priority lead has a documented next action

Monitor closely for the first few weeks. Watch for failed imports, duplicate records, unassigned leads, missed tasks, broken notifications, and any drop in response times. Assign one person to own this review daily. Ambiguity here is how leads slip through.

Real estate teams already lose 30-40% of inbound leads to slow follow-up under normal conditions. A poorly managed migration multiplies that risk fast.

Keep contact records, activity history, pipelines, and reports intact with a structured cutover plan. Ad hoc migrations tend to leak leads at exactly this stage.

Final CRM cutover checklist and post-migration monitoring priorities

Schedule a post-migration review once things stabilize:

  • Compare the new CRM against your original requirements list
  • Gather team feedback on what helps versus what gets in the way
  • Strip out unnecessary fields or workflows
  • Document the process for the next hire or future system change

The real measure of a successful CRM switch isn't whether your contact count matches. It's whether every lead still has an owner and a next action the day after cutover.

Frequently Asked Questions

Which CRM is best for real estate?

The best CRM depends on your team size, lead sources, transaction workflow, automation needs, integrations, and budget. Compare these criteria and data portability directly rather than choosing based on popularity alone.

How do I switch CRMs without losing real estate leads?

Complete a full backup, inventory your data, run staged test imports, rebuild workflows, verify lead routing, and operate both systems in parallel briefly. Finish with a validation of every active lead and open deal.

What data should I export before changing CRMs?

Export contacts with custom fields and tags, plus notes, activities, emails, texts, and tasks. Include deals, attachments, templates, automations, ownership, source data, and consent records where available.

Will my notes, emails, and automations transfer to a new CRM?

Transferability varies by platform. Activity history, attachments, integrations, and automations often require special exports, manual field mapping, or complete rebuilding from scratch.

Should I run two real estate CRMs at the same time?

A short, controlled overlap is useful for validation and historical reference. Route all new leads into only one designated system during this period to avoid conflicting or duplicate records.

How long does it take to migrate to a new real estate CRM?

A simple contact-file move can take days once data is clean and mapped. A full team transition with testing typically takes 2-3 weeks, while a brokerage-wide phased rollout can run 3-6 months depending on complexity.
