This isn't a job for IT alone. A dedicated internal project team, working hand-in-hand with your vendor's implementation specialists, needs to own this from day one. Rush the timeline, skip the testing cycles, or under-train your floor staff, and you'll pay for it during go-live week.
This guide walks through the full implementation lifecycle: planning, configuration, data migration, integration, testing, training, go-live, and what comes after.
TL;DR
- Follow a fixed sequence: assess needs, configure, migrate data, integrate, test, train, then go live
- Vendor fit for your specific workflows matters more than brand reputation
- Data migration and ERP/TMS integration carry the highest risk; budget dedicated testing for both
- Timelines run from a few weeks (simple, single-site) to 4-6 months for complex deployments
- Prioritize post-launch stability over immediate optimization
WMS Implementation Guide

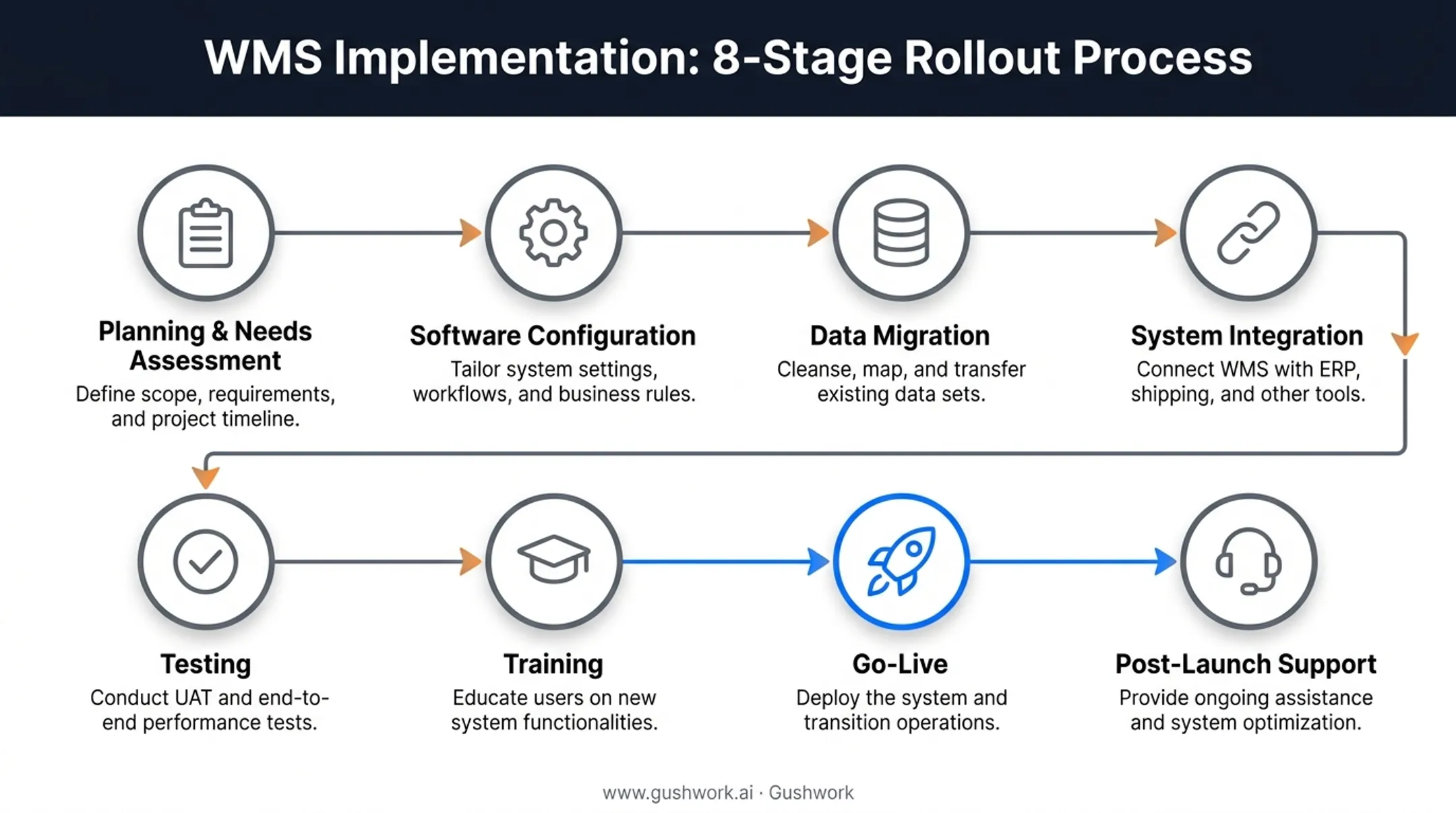

The full process breaks down into eight phases:
- Planning and needs assessment
- Software configuration
- Data migration
- System integration
- Testing
- Training
- Go-live
- Post-launch support

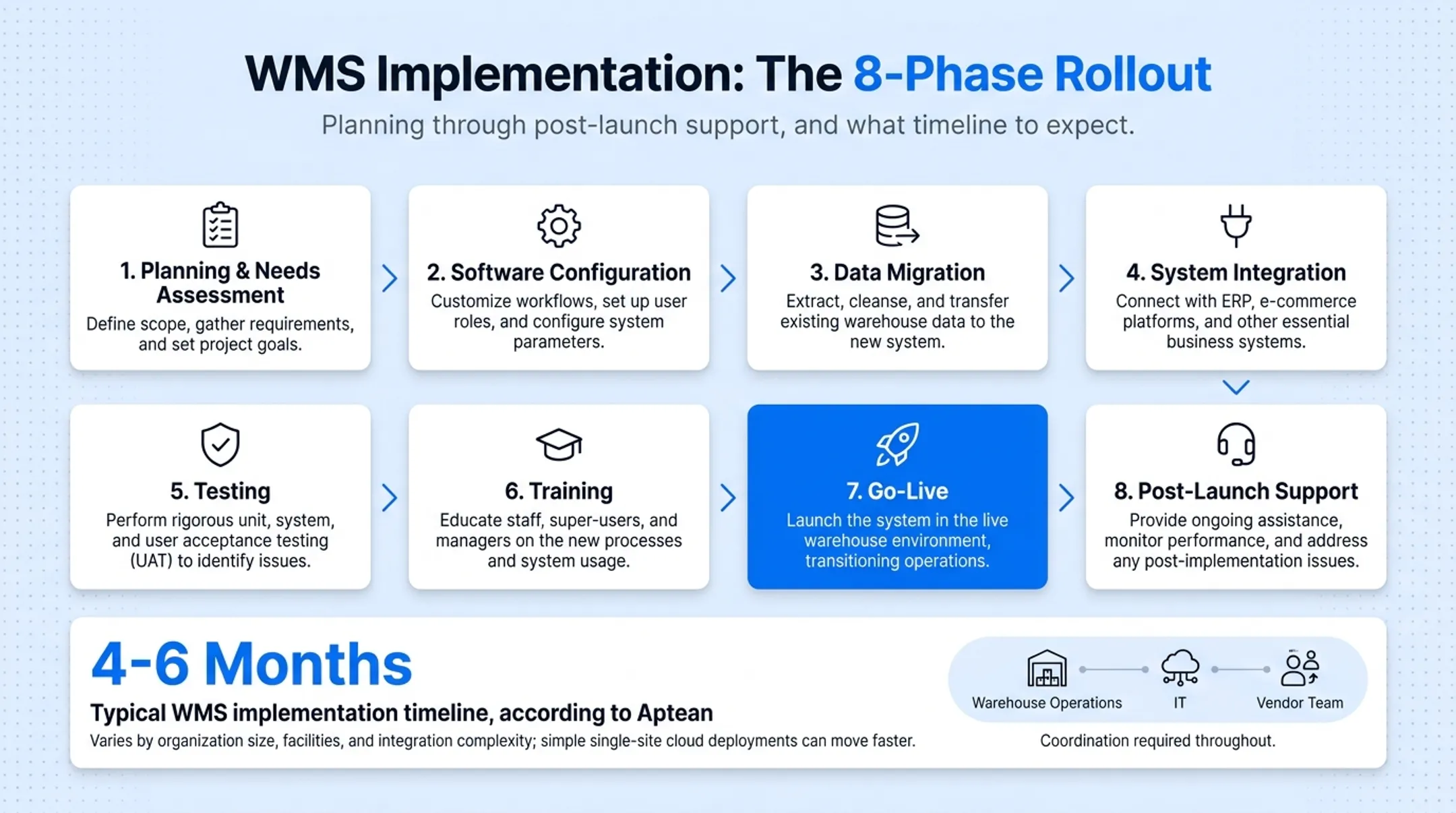

Timeline expectations matter here. A standard WMS implementation typically takes 4-6 months, according to Aptean, though this varies by organization size, number of facilities, and integration complexity. Simpler, single-site cloud deployments can move faster.
What doesn't change is the need for coordination across warehouse operations, IT, and your vendor's team throughout.
Prerequisites and Planning Considerations
Before configuration starts, get these pieces in place:
- Needs assessment — set clear objectives such as fewer picking errors or faster cycle times, and pull in warehouse-floor stakeholders—not just IT and management
- Compatibility checks — confirm the WMS works with your existing ERP, TMS, and hardware
- Core implementation team — name a project lead, data owner, and training lead at minimum, plus a communication plan the team actually follows
Supply Chain Management Review recommends detailed stakeholder workshops to map current-state processes before configuration begins. Warehouse process owners hold the operational knowledge; the implementation team translates that into system requirements and test cases, then the process owners sign off before anything gets built.
That sign-off is the gate. Non-negotiable: don't move to configuration without documented current-state workflows and stakeholder approval on requirements. Skipping this step is where most implementation timelines quietly blow up.

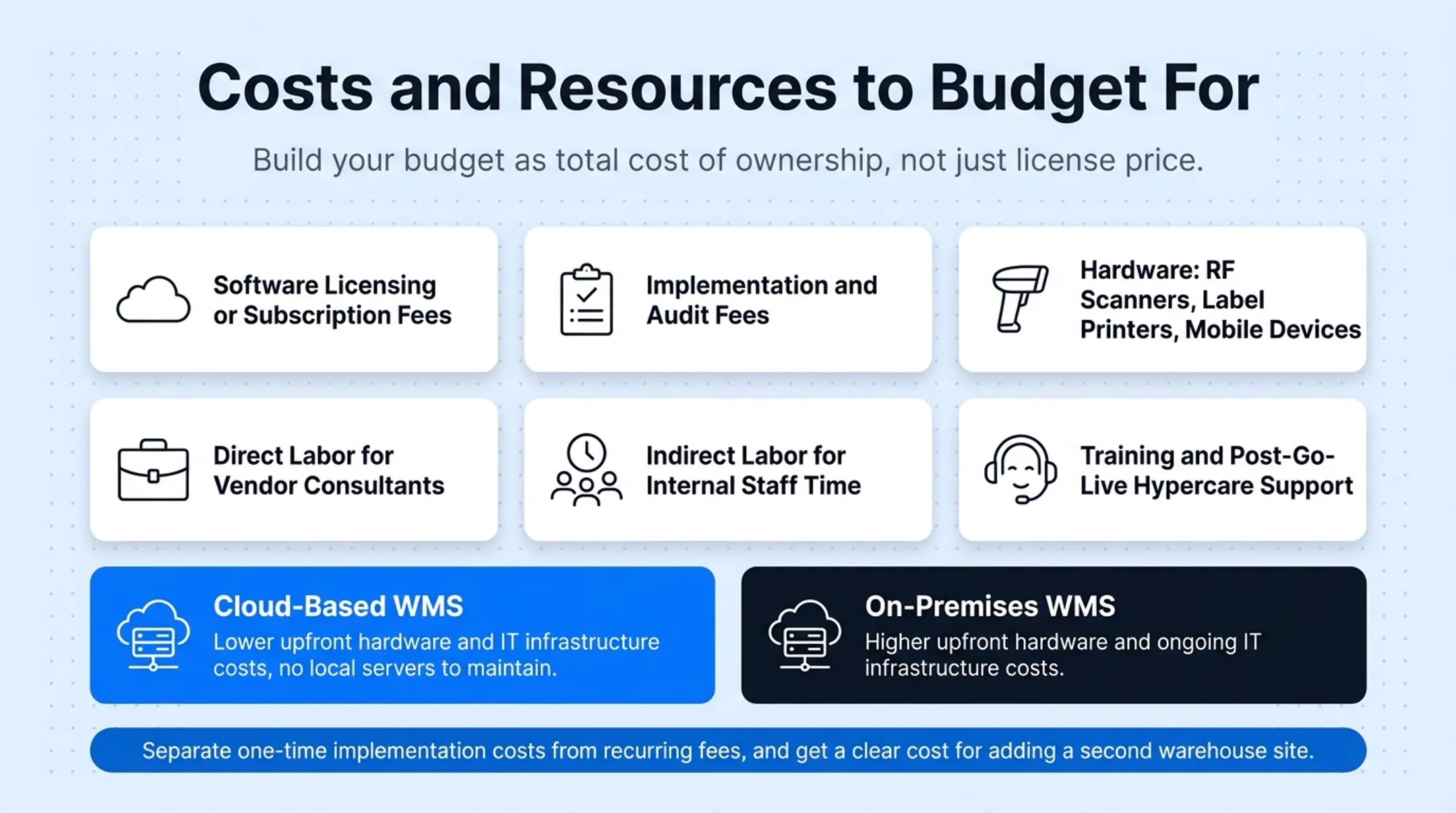

Costs and Resources to Budget For
Build your budget as total cost of ownership, not just license price. Typical categories include:
- Software licensing or subscription fees
- Implementation and audit fees
- Hardware such as RF scanners, label printers, and mobile devices
- Direct labor for vendor consultants
- Indirect labor for internal staff time pulled from other duties
- Training and post-go-live hypercare support
Cloud-based WMS platforms generally reduce upfront hardware and IT infrastructure costs compared to on-premises systems, since you're not maintaining local servers. Ask vendors to separate one-time implementation costs from recurring subscription fees, and get a clear number for what adding a second warehouse site would cost later.

How to Implement a WMS (Step-by-Step)
A solid WMS rollout follows four phases: configuration, integration, testing, and go-live. Skipping any of them—especially testing and documented test cases—is the single most common reason implementations hit costly post-launch issues.
Step 1: Software Configuration and Data Strategy
Configure the WMS around your actual warehouse layout, user permissions, and picking/putaway workflows. Default settings rarely match how your floor actually operates.
Run a data audit before touching anything else. Define master data standards and build a migration plan—with backups—covering:
- Inventory records
- Open orders
- Customer and supplier data
Your WMS needs to support multiple warehouses, location-level visibility, and barcode scanning from day one. Build that into the data structure now rather than retrofitting it later.

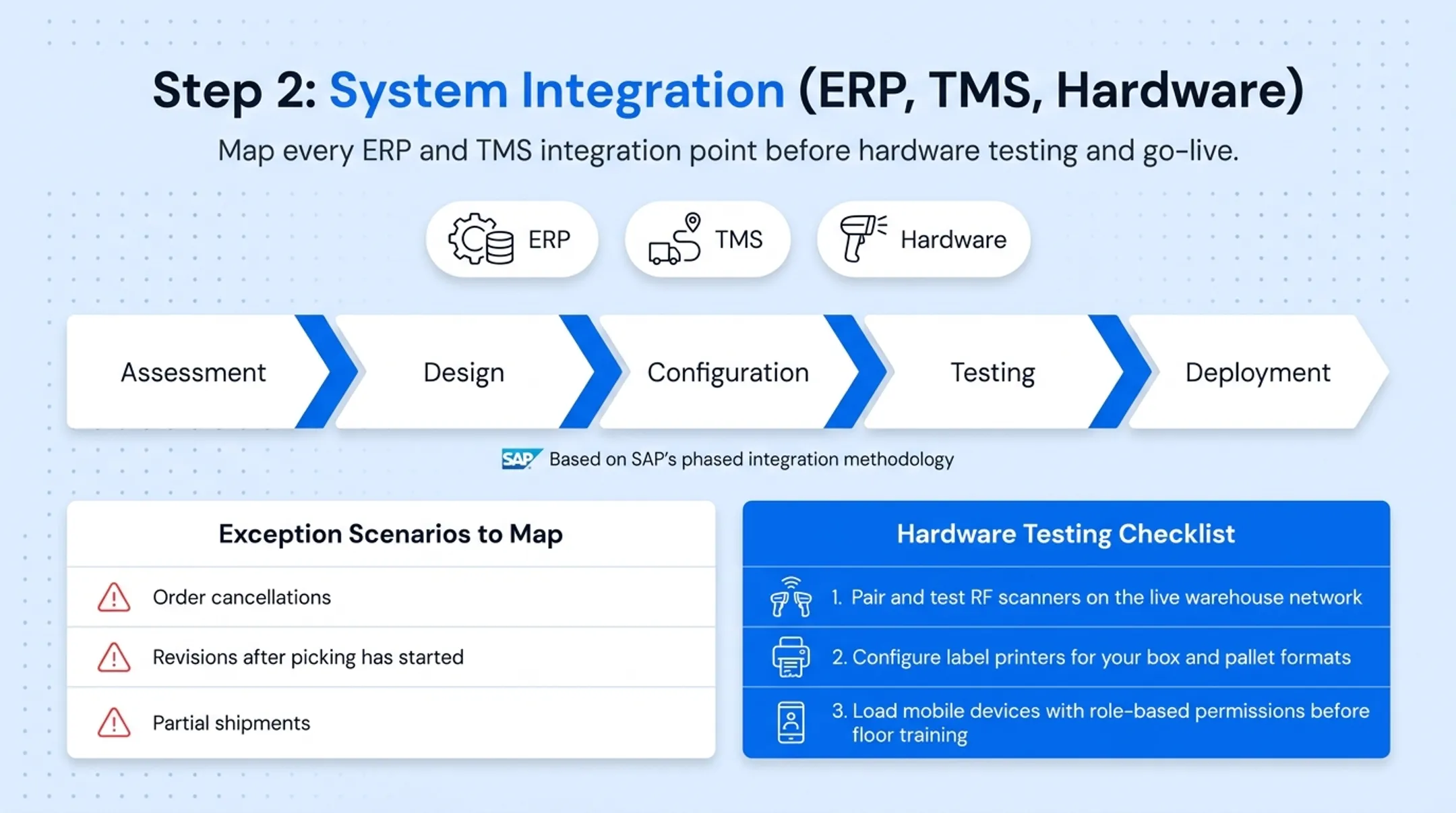

Step 2: System Integration (ERP, TMS, Hardware)
Document every integration point with your ERP and TMS systems. Pay particular attention to exception scenarios: order cancellations, revisions after picking has already started, partial shipments. These are the scenarios that get missed during design and cause headaches later.
SAP's implementation guidance recommends structuring integration work in distinct phases—assessment, design, configuration, testing, deployment—and flags integration as a common bottleneck when it's not planned early enough.
Test hardware ahead of go-live, not during it:
- Pair and test RF scanners on the live warehouse network
- Configure label printers for your box and pallet formats
- Load mobile devices with role-based permissions before floor training

Step 3: Testing and Validation
Build detailed test cases covering full end-to-end workflows, plus the edge cases nobody thinks about until they happen live. Documented requirements alone won't cut it.
Run at least two full system integration testing (SIT) cycles that simulate the actual cutover. SCMR's research is clear: production-like testing surfaces defects before go-live, when fixes still cost hours instead of days of downtime.
Step 4: Training and Go-Live
Train key users and team leads first, in phases, with hands-on sessions specific to their roles. Set expectations early that productivity will dip temporarily. It always does.
Go-live needs a minimally disruptive cutover plan:
- A system freeze window where no transactions happen in either system
- A documented contingency plan to revert if something breaks
- Floor support staff on-site for the first several shifts

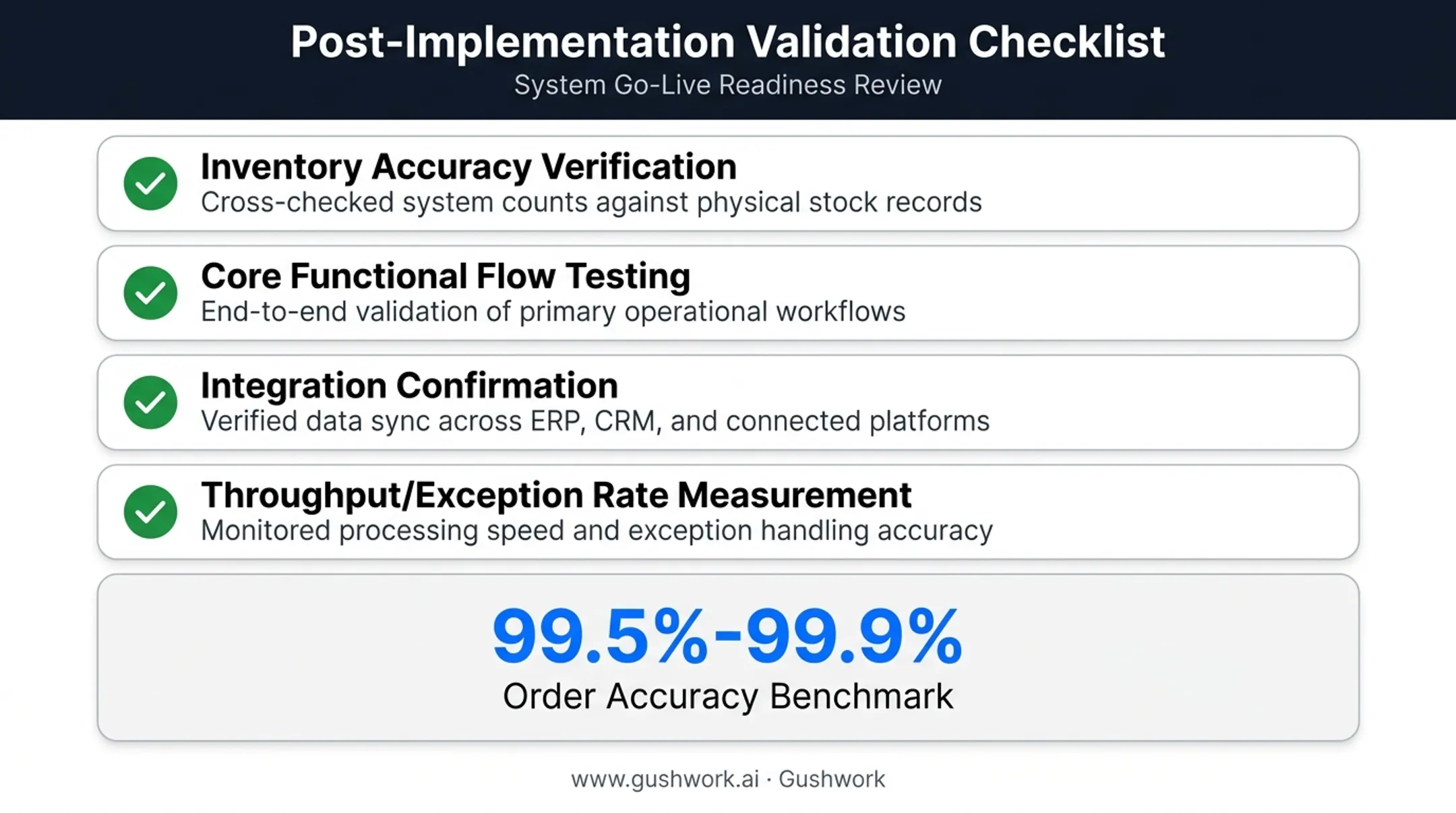

Post-Implementation Checks and Validation
Don't scale to full operations until you've confirmed the system actually works under real conditions.
- Verify inventory accuracy against physical counts, and confirm order accuracy rates meet or beat your legacy system's performance
- Test core functional flows — receiving, picking, packing, shipping — under real production volumes, not just test data
- Confirm integrations hold under live order traffic with your ERP, carriers, and connected sales channels
- Measure throughput and exception rates against pilot baselines before you release more volume
ASCM sets a order accuracy target of 99.5%-99.9%. Use that as your benchmark, but also compare directly against your own pre-WMS baseline.

Skipping this validation step is how scalability issues slip through unnoticed, only to surface later once you're running at higher volume than your pilot ever tested.
Common Implementation Problems and Fixes
Most WMS go-lives hit the same friction points: bad data, hesitant operators, and brittle integrations. Use the problem → cause → fix pattern below to diagnose quickly and recover without a full rollback.
Issue 1: Data Migration Errors
Problem: Inventory counts or master data don't match between legacy and new systems after go-live.
Likely cause: Incomplete data audit, or skipped backup/validation steps before migration.
Fix: Run a full data audit and reconciliation pass. Re-migrate only the discrepant records rather than starting over.
Issue 2: Staff Resistance and Slow Adoption
Problem: Operators revert to old habits, or make frequent errors on RF devices.
Likely cause: Insufficient hands-on training, or muscle memory conflicts with legacy system shortcuts.
Fix: Run additional phased training sessions and track error rate and picks per hour closely during the transition window.
Issue 3: Integration Failures with ERP/TMS
Problem: Order or shipment data doesn't sync correctly between the WMS and other systems.
Likely cause: Exception scenarios (cancellations, revisions) weren't mapped during the design phase.
Fix: Document and test every exception path, then patch the integration logic before attempting go-live again.

Pro Tips for a Smoother WMS Implementation
- Pilot at a representative but manageable site, while designing your technical architecture for your highest-volume facility. Building small and hoping it scales later is how you end up rebuilding it in year two.
- Don't redesign processes and roll out new software simultaneously. Stabilize the system on your existing processes first, then optimize.
- Document sign-offs at every phase (requirements, testing, training) to maintain accountability if something goes wrong later.
- Bring in a specialist when your internal team lacks WMS-specific experience. Custom integration and implementation need dedicated technical bandwidth most SMB teams don't have sitting idle.
At Gushwork, we handle this implementation and integration work directly for manufacturers, industrial distributors, and equipment suppliers who need a warehouse management system built around their actual operations rather than a generic template.
Conclusion
The quality of your implementation directly determines whether your WMS delivers on inventory accuracy, faster order fulfillment, and long-term ROI. A rushed go-live rarely saves time in the long run. It just moves the pain to after launch.
Plan carefully, test with discipline, and roll out in phases rather than all at once—that discipline is what protects accuracy, speed, and ROI after go-live.
Frequently Asked Questions
How do I implement a warehouse management system?
Use a phased approach: needs assessment, configuration, data migration, ERP/TMS integration, testing, training, and go-live. Document sign-off at each phase before moving on.
How much does a WMS implementation cost?
Costs vary by warehouse size and system type, covering software licensing, hardware, labor, and training. Cloud-based systems generally carry lower upfront costs than on-premises deployments.
What are the five S's of warehouse management?
The five S's (Sort, Set in order, Shine, Standardize, and Sustain) are lean organization principles from the Toyota Production System. They build the operational discipline that makes WMS adoption stick.
How long does a WMS implementation typically take?
Timelines range from a few weeks for simple, single-site cloud rollouts to 4-6 months or more for complex, multi-site, or heavily integrated deployments.
What is the biggest risk during WMS implementation?
Data migration errors and inadequately tested integration exception scenarios (like order cancellations mid-pick) top the list. Both require dedicated testing cycles, not just documentation review.
Should I customize my WMS or use standard configurations?
Use standard configuration wherever it meets your documented requirements. Reserve customization for genuinely unique operational needs. That keeps cost and complexity under control.
