Wave Planning in Warehouse Management Rising order volumes and tight carrier cut-off windows have turned manual order release into a daily fire drill for many warehouses. Pickers wait on releases, trucks idle at the dock, and labor gets bunched at the wrong hours. Wave planning fixes this by grouping orders into scheduled batches based on shipping deadlines, zones, and priorities — instead of releasing orders one by one as they land.

This article breaks down how wave planning works, the main wave types, what a wave planner actually does day to day, and the best practices that keep waves on schedule even when volume spikes.

Key Takeaways

  • Wave planning groups orders into scheduled batches to cut picker travel time and dock congestion
  • Common strategies include time-based, priority-based, zone-based, and hybrid waves
  • A wave planner balances labor, inventory, and shipping schedules before and during execution
  • Success depends on accurate WMS data, not guesswork or static schedules

What Is Wave Planning in a Warehouse?

Wave planning is the pre-release strategy: deciding which orders get grouped together, when they release, and under what criteria. Wave picking is the physical execution that begins the moment a wave is released. Wave management is the real-time oversight of waves already on the floor.

Oracle's warehouse management documentation draws this line clearly: releasing a wave triggers pick release and allocates inventory to orders, but everything before that point is planning, not execution. Extensiv separates it further: planning sets the schedule and criteria before work starts, while management supervises and adjusts tasks already in motion.

How Orders Move Into a Wave

Orders don't get released the instant they arrive. They sit in an order pool, a holding area where incoming orders accumulate until the WMS groups them based on set criteria:

  • Carrier cut-off times: orders due for pickup within a specific window
  • Shipping priority: expedited vs. standard orders
  • Order type: B2B bulk vs. single-unit shipments
  • Warehouse zone: which pick areas the items live in

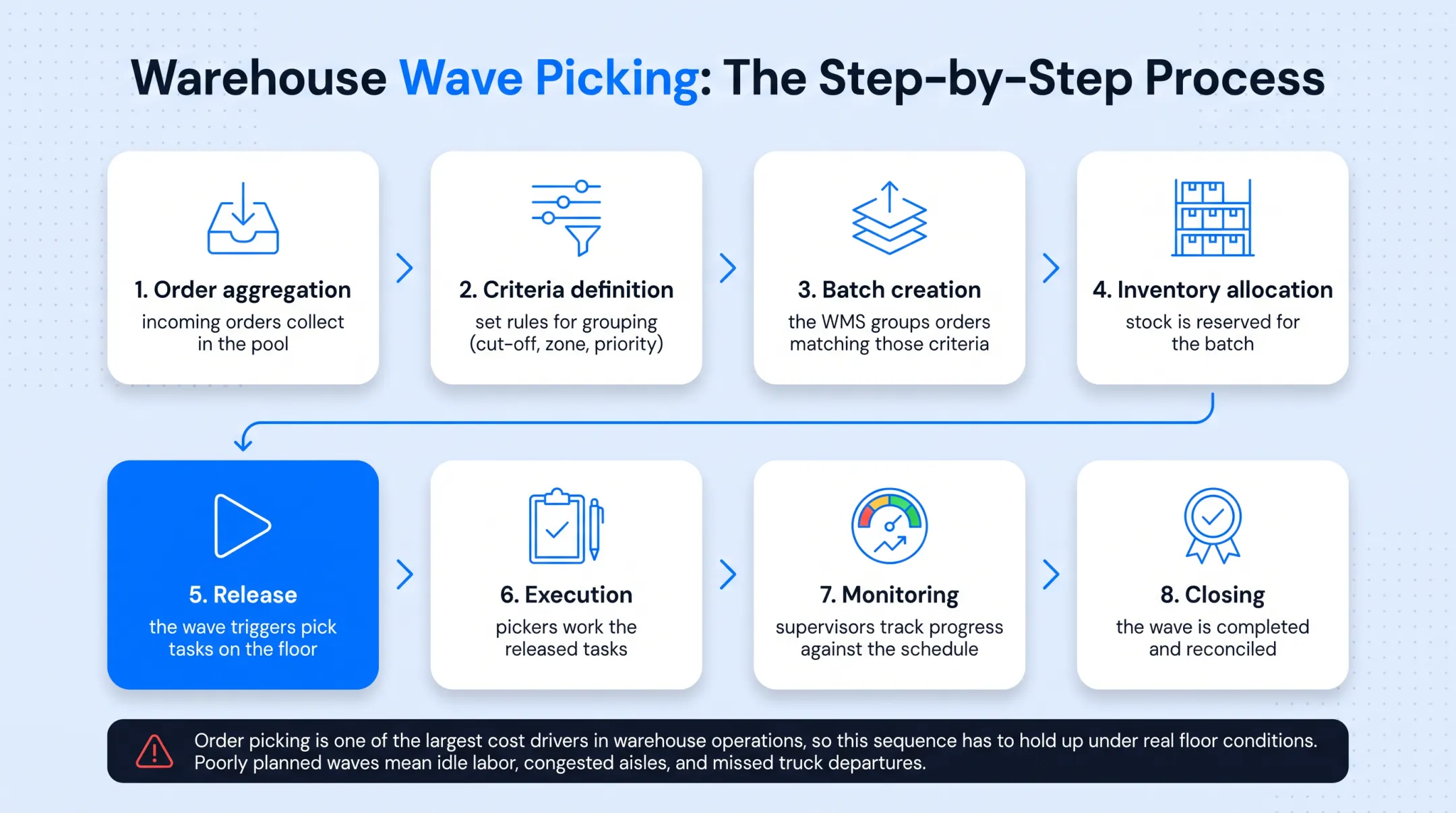

The Step-by-Step Process

  1. Order aggregation: incoming orders collect in the pool
  2. Criteria definition: set rules for grouping (cut-off, zone, priority)
  3. Batch creation: the WMS groups orders matching those criteria
  4. Inventory allocation: stock is reserved for the batch
  5. Release: the wave triggers pick tasks on the floor
  6. Execution: pickers work the released tasks
  7. Monitoring: supervisors track progress against the schedule
  8. Closing: the wave is completed and reconciled

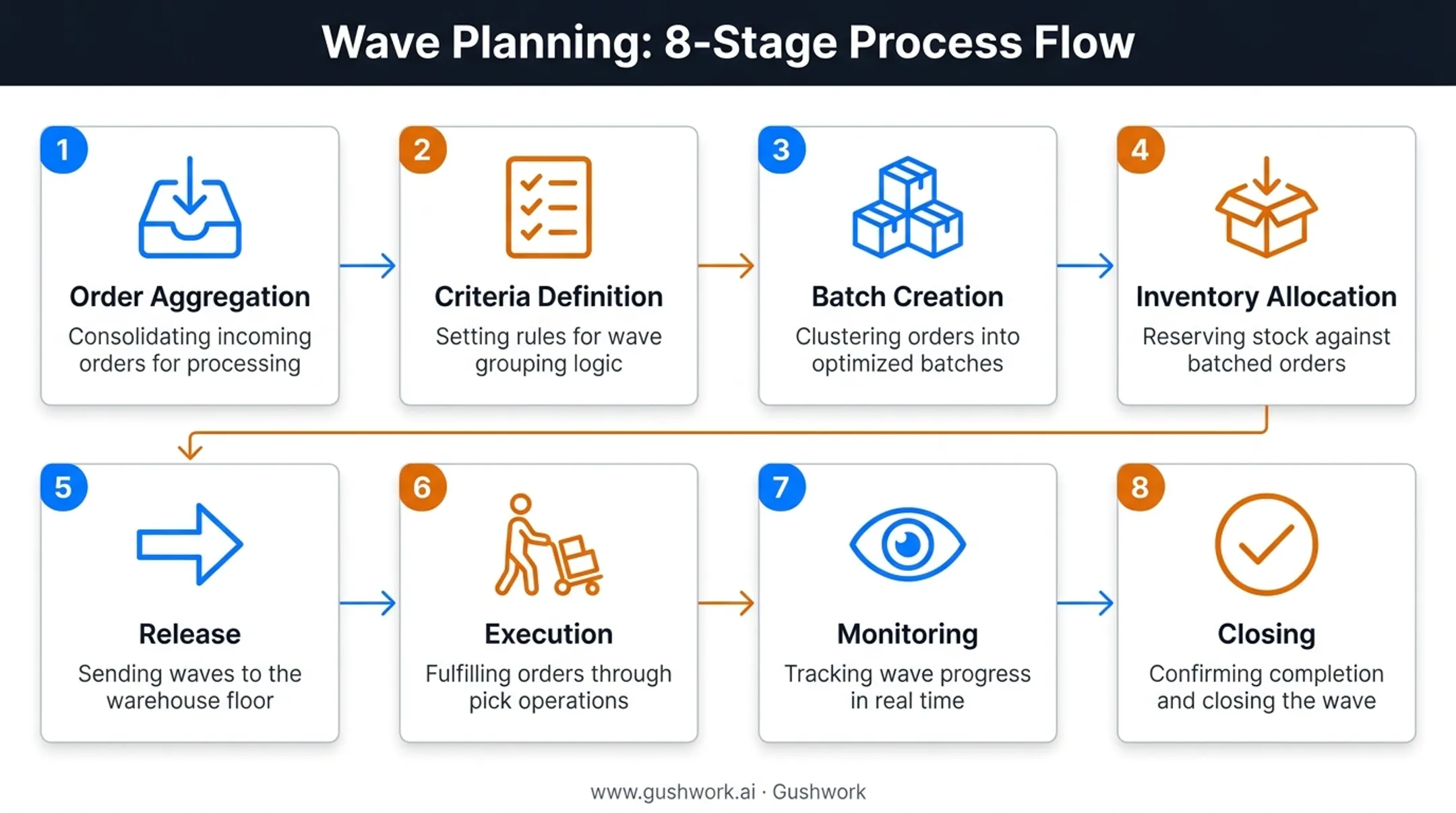

8-step wave planning process from order aggregation to closing

Order picking is one of the largest cost drivers in warehouse operations, so this sequence has to hold up under real floor conditions. Poorly planned waves mean idle labor, congested aisles, and missed truck departures.

Digital vs. Wholesale Wave Planning

B2C digital fulfillment and B2B wholesale operations plan waves differently. Digital (B2C) runs high order volume, small unit counts, and frequent short waves tied to parcel carrier pickups. Wholesale (B2B) handles fewer, larger orders with longer lead times, and builds waves around pallet consolidation and freight scheduling rather than tight parcel cut-offs.

What Does a Wave Planner Do?

A wave planner sits between demand and capacity, constantly balancing three variables: labor availability, equipment capacity, and shipping schedules. Get any one of these wrong and the wave either sits half-staffed or overwhelms the floor.

Prioritizing by SLA

The planner sets release triggers based on service-level agreements. Orders with tighter delivery promises get pulled into earlier waves, while standard orders fill in around them. Oracle's documentation notes that planners can add or remove order lines before release when fill-rate or labor projections don't match reality. That flexibility disappears the moment a wave is released.

Monitoring and Adjusting in Real Time

Once a wave is live, the planner's job shifts to oversight:

  • Watching pick rates against the schedule
  • Reassigning labor when one zone falls behind
  • Splitting a wave if volume or a disruption threatens the shipping window
  • Flagging exceptions before they cascade into missed cut-offs

Extensiv describes this as real-time wave visibility: spotting a bottleneck in a specific aisle, then reprioritizing tasks or shifting workers to clear it. Catching a bottleneck mid-wave beats discovering it at the dock door.

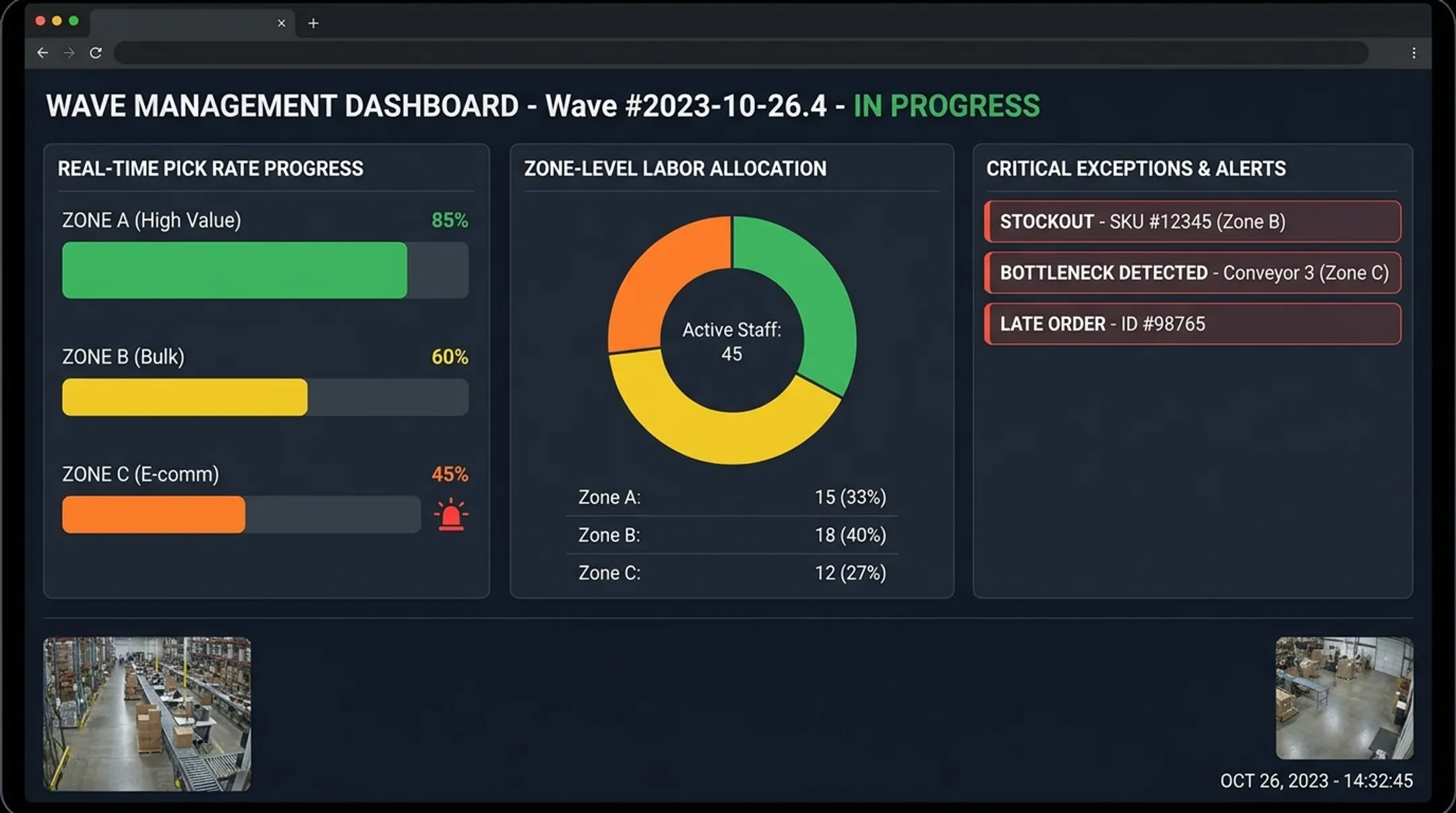

Warehouse wave management dashboard showing real-time pick rate monitoring

Types of Wave Planning Strategies

Most warehouses don't use just one wave type. They layer strategies depending on order mix and peak demand.

Strategy How it works Best for
Time-based Waves release at fixed intervals tied to carrier cut-offs Predictable, scheduled shipping
Priority-based High-priority and expedited orders get pulled into earlier waves SLA-sensitive fulfillment
Zone-based Warehouse divided into picking zones, consolidated centrally Large facilities with distinct pick areas
Hybrid Combines time, zone, and priority rules with AND/OR logic High-SKU, complex operations
Waveless/continuous Orders release as soon as they meet fulfillment criteria, no batch wait Very high-velocity, real-time operations

Oracle's platform supports the hybrid approach directly, with multiple linked rules across order, customer, carrier, and delivery attributes.

JASCI's 2025 WMS trends coverage also flags continuous flow as an emerging option, releasing orders individually instead of waiting on a scheduled wave. Continuous flow does not replace wave planning in every facility, but it is gaining traction where speed matters more than batch efficiency.

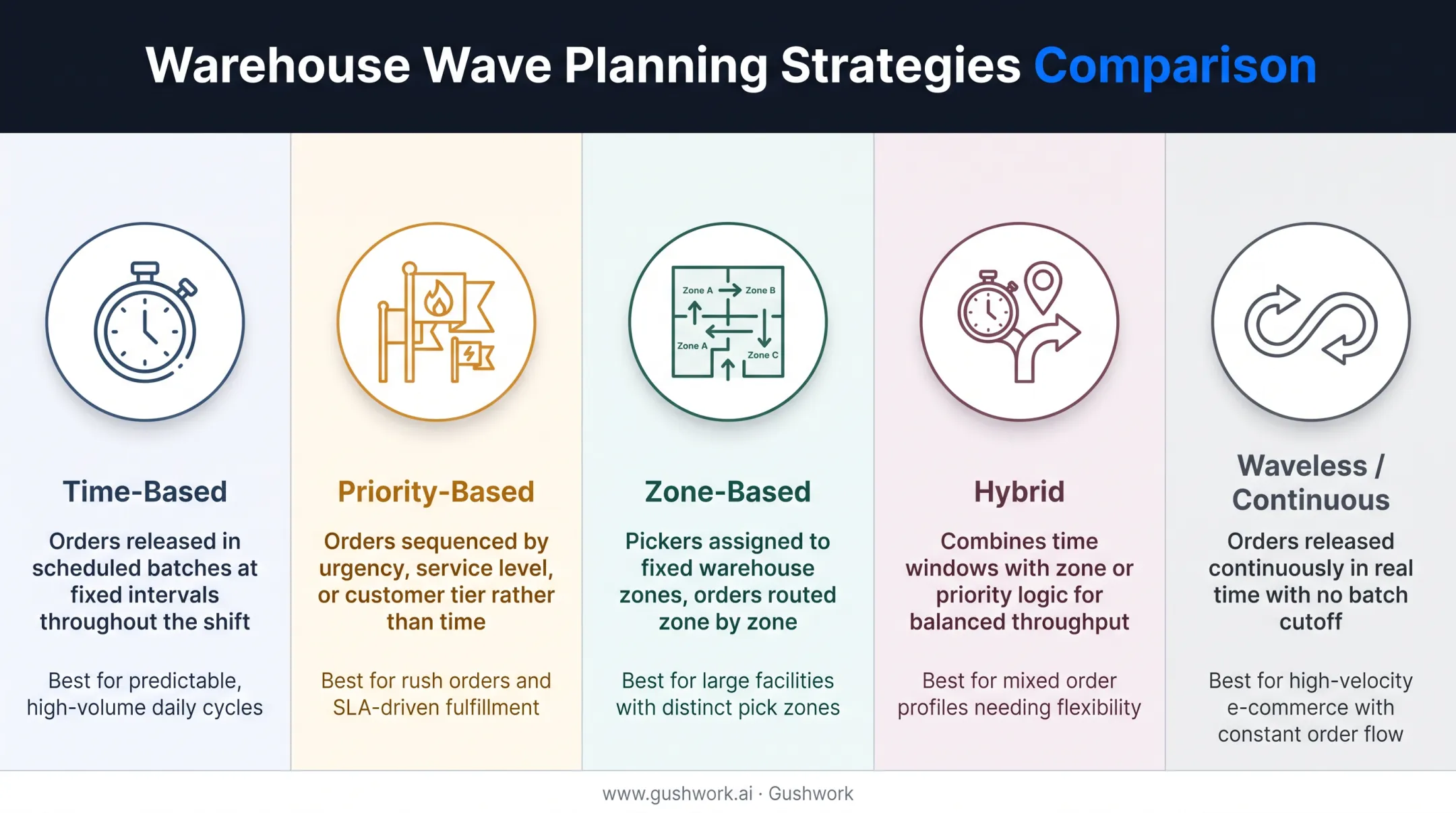

Comparison of five warehouse wave planning strategy types and use cases

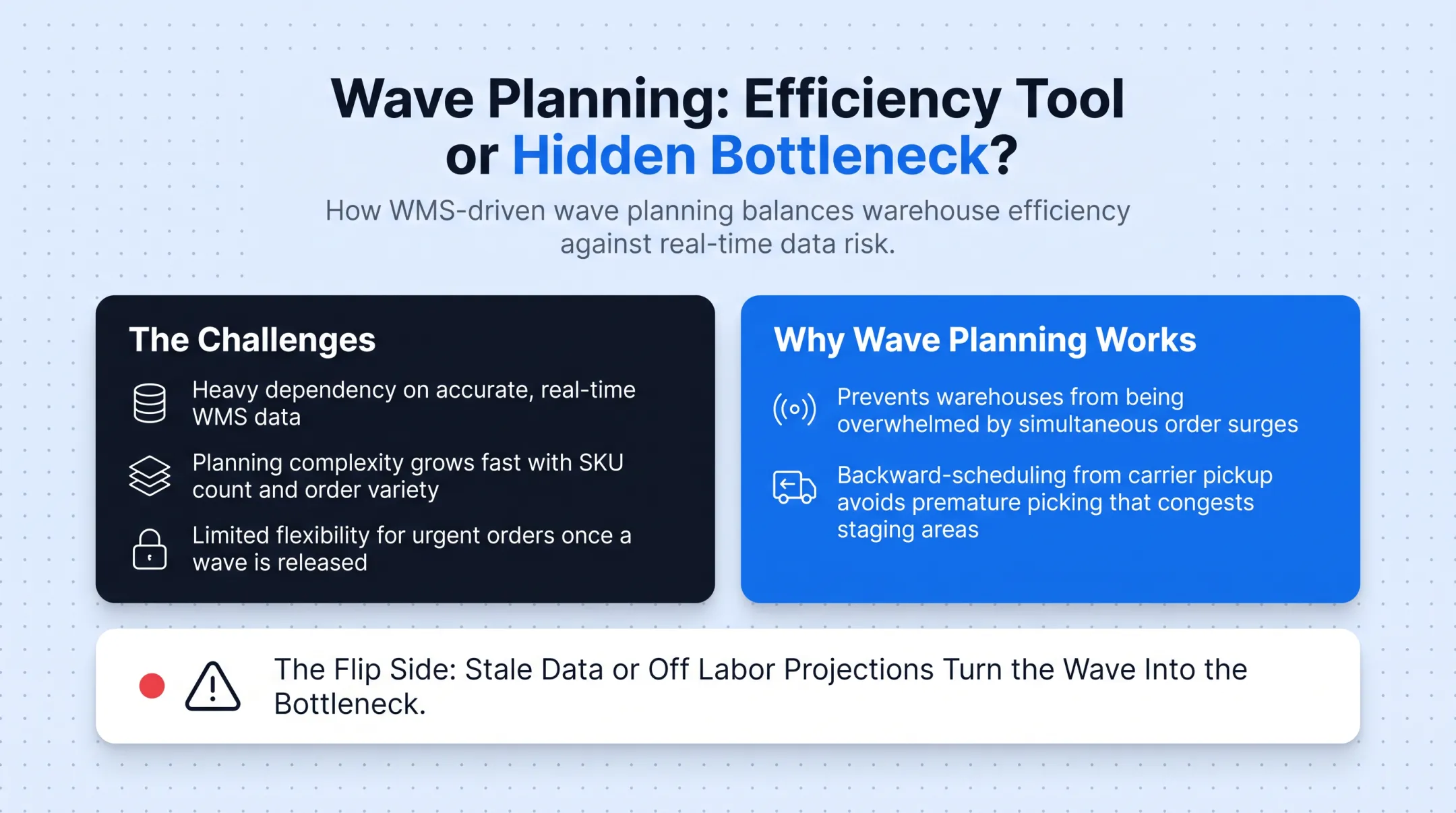

Benefits and Challenges of Wave Planning

Wave planning can cut travel, speed fulfillment, and steady labor—but only when the data and assumptions behind each release hold up.

Benefits

  • Reduced picker travel time through zone consolidation
  • Faster fulfillment cycles by matching releases to carrier windows
  • Better labor utilization across shifts and zones
  • Improved inventory accuracy through allocation checks before release

Challenges

  • Heavy dependency on accurate, real-time WMS data
  • Planning complexity grows fast with SKU count and order variety
  • Limited flexibility for urgent orders once a wave is released

Infios notes that wave planning keeps warehouses from being overwhelmed by simultaneous order surges. Backward-scheduling from carrier pickup also avoids premature picking that congests staging areas.

The flip side is simple: if the underlying data is stale or labor projections are off, the wave itself becomes the bottleneck instead of the fix.

Busy warehouse dock with workers loading pallets onto trucks

Best Practices to Optimize Wave Planning

Apply these practices to keep waves predictable under real floor conditions:

  • Align schedules with carrier cut-offs. Build in a buffer before departure so a minor delay doesn't cascade into a missed truck.
  • Use real-time WMS data continuously. Static schedules break when order volume shifts; live visibility catches fill-rate or labor mismatches before release.
  • Balance workloads across zones. During peaks, shorter and more frequent waves spread labor demand more evenly than a few large ones.
  • Review wave KPIs after every cycle. Track on-time departure, pick productivity, and short-ship rates so the next plan improves on the last.

Frequently Asked Questions

What is wave planning in a warehouse?

Wave planning is the strategic process of grouping orders into scheduled batches based on shipping deadlines, warehouse zones, and priority levels. It happens before pick release, not during it.

What does a wave planner do?

A wave planner sets release schedules, balances labor and equipment capacity against order volume, and adjusts waves in real time when disruptions or volume spikes occur.

What is the difference between wave planning and wave picking?

Wave planning is the strategy — deciding how orders get grouped and scheduled. Wave picking is the physical execution that begins once a wave is released to the floor.

What is the difference between wave planning and wave management?

Wave planning sets the schedule and criteria before work starts. Wave management is the real-time supervision and adjustment of waves that are already running.

How does wave planning handle sudden spikes in order volume?

Planners can split an active wave or reassign labor between zones to keep the schedule intact. This flexibility is easier before release than after, since allocated inventory and assigned tasks are harder to reshuffle mid-wave.

Which industries benefit most from wave planning?

E-commerce, retail, food distribution, and industrial supply all deal with high order volume and tight deadlines, making them the strongest fits for structured wave planning.
